Skip to main content
🇲🇾 11 years in Malaysian property · Johor Bahru & Kuala Lumpur new launches
KLCC, Kuala Lumpur · Under construction

Hugoz Suites @ KL City Centre

Freehold, 320 units, targeting September 2027 — and on EXSIM’s own permit the cheapest unit is RM915,515, below the RM1 million foreign-buyer floor.

Freehold · no restriction in interest320 units on the permit3 layouts · 323, 452 and 646 sq ftRM915,515 – RM1,345,960GreenRE Gold (provisional), Feb 2024Quarterly site photos since Q1 2025

⚡ Typical reply within 15 minutes, 9am–10pm MYT · No obligation

320Units on the permit
323Sq ft, smallest layout
2027Target completion
Hugoz Suites @ KL City Centre tower facade on Jalan Yap Kwan Seng, Kuala Lumpur, by EXSIM Group
Hugoz Suites @ KL City Centre · artist’s impression, EXSIM Group
Champagne Sky Infinity Pool on Level 43A at Hugoz Suites @ KL City Centre, Kuala Lumpur
Level 43A · Champagne Sky Infinity Pool
Ground-level Entrance Statement and grand arrival at Hugoz Suites @ KL City Centre
Ground level · Entrance Statement
Answer block

Hugoz Suites @ KL City Centre at a glance

Everything in this table comes from the advertising and sale permit particulars printed at the foot of hugoz.com.my. That block is a statutory disclosure, not marketing copy, which makes it the most reliable thing on the whole website — and it disagrees with the property portals on two important numbers.

Development
Hugoz Suites @ KL City CentreArmada Istimewa Sdn Bhd (1085375-U), EXSIM group
Tenure and encumbrance
Freehold · no restriction in interestLand charged to CIMB Bank Berhad, per the permit
Development type
Serviced apartment (pangsapuri servis)Approving authority: Dewan Bandaraya Kuala Lumpur
Units
320Permit figure. Listing sites quoting 674 are not using this permit
Layouts
3 published · 323, 452 and 646 sq ftType C is drawn as a studio office, not a home
Price range
RM915,515 – RM1,345,960Permit figures, 2% Bumiputera discount
Target completion
September 2027Stated on the permit; check it against the quarterly site photos
Green certification
GreenRE Gold, provisionalAnnounced by EXSIM on 19 February 2024 — design stage, not as-built

Explore related topics

Curated hubs, each with its own guide — not auto-generated tag archives.

Why this address

Six things to settle before you book at Hugoz Suites

Freehold in KLCC, a real MRT interchange four hundred metres away, a developer that actually publishes construction photos — those are genuine strengths. The complications are all about which unit, because the three layouts in this tower are not the same legal product and they do not all clear the same thresholds.

💸

The cheapest units are below the foreign-buyer floor

The permit states a selling price range of RM915,515 to RM1,345,960. Kuala Lumpur prohibits foreign interests from acquiring any property valued at under RM1,000,000 per unit, and “foreign interests” includes Malaysian permanent residents. So a non-citizen cannot buy at the bottom of this price list at all — only the upper part of the range is open to you. This is the single most consequential fact on the page for a foreign buyer, which is why it is at the top and not buried in the FAQ.

🏢

One of the three layouts is an office, and that changes everything about it

EXSIM’s own unit plan labels Type C as Studio Office, 323 sq ft, with a room schedule of pantry, office and washroom. Types A and B are drawn as residential suites. If Type C sits on commercial title, the consequences are concrete: commercial assessment rates and utility tariffs, a lower bank margin, and — for a foreign buyer — the Ministry of Economy requirement that commercial property acquired by foreign interests be registered in the name of a company incorporated in Malaysia. There is a tax difference too: the 8% non-citizen stamp duty applies to residential property, and the statute’s definition of residential covers a service apartment or SOHO, not an office lot. Get the title class for your specific unit in writing.

🔢

320 units on the permit, 674 on the portals

The statutory permit block on hugoz.com.my states 320 units and describes the development type as serviced apartment. Property portals routinely quote 674 units and 46 levels. Both cannot describe the same permit. The most likely reading is that the studio office component sits under a separate approval that EXSIM has not published — but I am not going to assert that without the document. What you should do is simple: ask for every permit number covering the tower, and count what is actually being sold. Unit count drives your lift ratio, your share of maintenance and, most of all, how many identical units will compete with yours on the resale market.

🚇

Ampang Park interchange is about 400 metres away — measured

From the mapped construction parcel, the MRT Putrajaya Line station box at Ampang Park is roughly 390 metres in a straight line, and the Kelana Jaya LRT station about 610 metres. Two lines within walking distance is genuinely rare in this part of town, and it is the strongest structural argument for the address. The Petronas Twin Towers are about 840 metres away, which is a walk you would actually make.

🏗️

The developer’s next tower is fifty metres away

EXSIM is building Phoeniz Suites on the adjoining parcel — mapped roughly fifty metres from the Hugoz site, same operator, same neighbourhood, same buyer profile. When Phoeniz completes, its stock competes with yours for the same tenants and the same resale buyers, and it will be newer. That is not a reason to avoid Hugoz; it is a reason to ask when Phoeniz launches, at what price, and how many units, before you decide what Hugoz is worth to you.

📉

Small serviced apartments are the most crowded shelf in Kuala Lumpur

NAPIC’s first-quarter 2026 numbers for Kuala Lumpur record 4,181 unsold completed serviced apartment units, on top of 3,733 units of residential overhang. Completed and unsold is the category that sets the rental ceiling, because those units are already available and their owners are already carrying costs. A 323 or 452 sq ft suite in KLCC is precisely the product that shelf is full of. The counter-arguments here — freehold, two rail lines, an office-and-embassy catchment — are real, but they need to be priced, not assumed.

Project DNA

The whole development, decoded

One tower, four levels of shared space, and a facilities programme that is unusually top-heavy: almost everything social sits on Level 41 and Level 43A rather than above the car park. That is EXSIM’s signature, and it has consequences for how much this building costs to run.

320Units on the permit
3Published layouts
4Facility levels
323Sq ft, smallest

Pick your tower

Sky facilities deck above Kuala Lumpur at Hugoz Suites @ KL City Centre
Freehold serviced apartments

Hugoz Tower

One tower on a freehold parcel, with the permit covering 320 serviced apartment units. Shared space is split across four levels: retail and arrival at ground, a garden and play deck at Level 8, the lounges, bar, games room and co-working floor at Level 41, and the entire pool deck at Level 43A. EXSIM does not publish the total storey count, so the number of residential floors above 43A is not stated anywhere on its site.

320Units
43APool deck level
3Layouts
A · 452 sq ft, 1 bedroom 1 bathroomB · 646 sq ft, 1 bedroom 2 bathroomsC · 323 sq ft, studio officeDual-key modification offered as an option
💬 Ask about Hugoz Tower

Facilities, level by level

Taken from EXSIM’s own numbered facilities plans for Levels G, 8, 41 and 43A. Two things the plans do not tell you: how many storeys the tower has in total, and how the Culinary Party Deck — listed under Level 41 but marked “Level 43” on the same plan — is numbered on the stamped drawing. Ask for the approved facilities plan before you sign.

Pool deck

Level 43A
  • Champagne Sky Infinity Pool
  • Champagne Tower Pool
  • Bubble Pool
  • Starry Pool Deck
  • Cellar Pool Cabana
  • Rim Deck
  • Sky Coliseum

Sky social floor

Level 41 (Culinary Party Deck marked Level 43)
  • Sky Music Bar & Lounge
  • Gallant Hall
  • Noble Room
  • Superior Lounge
  • Games Room
  • CoWorking Lounge
  • Culinary Party Deck

Garden and play deck

Level 8
  • Adrenalin Lounge (gym)
  • Cologne Garden Lounge
  • Gallery Lounge
  • Tendon Garden
  • Secret Herbs Garden
  • Play Room

Arrival and retail

Ground level
  • Entrance Statement
  • Grand Arrival
  • Concierge
  • Regal Lounge
  • Al Fresco Retail

Where the project is now

14 February 2023Developer’s licence 30370/02/2028/0047(A) issued, valid to 13 February 2028
15 September 2023Advertising and sale permit issued, valid three years
24 November 2023Project published on the EXSIM group site with its full image set
19 February 2024GreenRE Gold provisional certification announced
Q1 2025First quarterly site progress photographs published
Q3 2026Latest published site photographs — structure well advanced
14 September 2026Advertising and sale permit expires — ask for the renewed number
September 2027Expected completion date stated on the permit
Layouts

All 3 Hugoz Suites @ KL City Centre floor plans

Three layouts, and they are not three versions of the same thing. Types A and B are drawn as homes, with a bedroom, living, dining and kitchen. Type C is drawn as a studio office — its room schedule lists a pantry, an office and a washroom, and nothing else. Read the drawing, not the headline.

Hugoz Suites Type C floor plan — 323 sq ft studio office with pantry and washroom, Kuala Lumpur

Type C — 323 sq ft

Studio office · 30 sqm · pantry, office and washroom only

🏢 Studio office🚿 1 Washroom
Get this floor plan
Hugoz Suites Type A floor plan — 452 sq ft one-bedroom one-bathroom suite, Kuala Lumpur

Type A — 452 sq ft

1 bedroom · 42 sqm · dining, kitchen, living, bedroom, bathroom

🛏 1 Bed🛁 1 Bath🍳 Kitchen
Get this floor plan
Hugoz Suites Type B floor plan — 646 sq ft one-bedroom two-bathroom suite, Kuala Lumpur

Type B — 646 sq ft

1 bedroom · 60 sqm · bathroom plus powder room

🛏 1 Bed🛁 2 Baths🔑 Dual-key option
Get this floor plan
Location & connectivity

Where Hugoz Suites @ KL City Centre sits

Jalan Yap Kwan Seng, 50450 Kuala Lumpur — in the office and embassy pocket north of the Petronas Twin Towers, between Jalan Ampang and Jalan Tun Razak, with Ampang Park interchange a few minutes on foot. Sales gallery: EXSIM KL Sales Gallery, G-01 Menara Sutera Damai, No 10 Lorong Yap Kwan Seng, Bukit Kewangan, 50450 Kuala Lumpur.

📍 3.1641959, 101.715423950450 KLCC

The project website names the street; it does not publish a lot number or a coordinate. The pin above is the OpenStreetMap construction parcel tagged Hugoz Suites KL City Centre, operator EXSIM, carrying the project’s own website address. That parcel record lists the lots as 53, 54, 55 and 56 off Jalan Liew Weng Chee, the service road that runs behind Jalan Yap Kwan Seng. Ask for the lot and section number on your booking form so the address on your sale and purchase agreement matches the land.

On the street name. Several listing pages place this project on Jalan Tun Razak. EXSIM’s own project website says Jalan Yap Kwan Seng, and the mapped construction parcel sits on the Yap Kwan Seng block, not on Tun Razak. The two roads are a few hundred metres apart and they are not the same address for traffic, for noise or for valuation comparables.
💬 Ask me about the real drive times
  • Ampang Park MRT station (PY20), Putrajaya LineAbout 390 mstraight line, calculated from mapped coordinates
  • Ampang Park LRT station (KJ9), Kelana Jaya LineAbout 610 mstraight line
  • Petronas Twin Towers and Suria KLCCAbout 840 mstraight line — a walkable distance
  • Phoeniz Suites, EXSIM’s adjoining projectAbout 50 madjoining parcel, same developer group
  • Jalan Ampang embassy and office corridorAdjacentthe tenant catchment for this address
  • AKLEH elevated highwayNearbyno official distance published
  • Tun Razak Exchange (TRX)One rail interchange awayon the same MRT line as Ampang Park
The government record

The statutory name is Menara Sutera Ria — and the licence is held by Armada Istimewa Sdn Bhd

This page contrasts what EXSIM published for one development against what it published for another. The National Housing Department file gives the same set of facts for this one, from a source that does not depend on a developer choosing to publish.

Project codeRegistered nameLicensed developerAdvertising permitPermit expiresUnitsBed / bathPrice band on the permitBuiltStatus
30370-1Menara Sutera Ria (Hugoz Suites @ KL City Centre)Armada Istimewa Sdn Bhd (30370)30370-1/09-2027/0668(R)-(S)14 Sep 20273201 / 1–2RM915,515 – RM1,345,96070.12%Lancar

Swipe sideways to see the full table →

How to run this check yourself — the seven status words, why searching by marketing name fails, and the register status of all 175 developments on this site →

Read from teduh.kpkt.gov.my on 27 August 2026. Pull it yourself: teduh.kpkt.gov.my/semakan-status-kemajuan?kodProjek=30370-1

Foreign buyers: the band straddles the threshold

The Kuala Lumpur minimum for a non-citizen buyer is RM1,000,000. The permitted band here runs from RM915,515 to RM1,345,960 — so part of this development qualifies and part of it does not.

That makes this a unit-level question, not a scheme-level one. Do not accept “foreigners can buy at Hugoz” as an answer. Ask about the specific unit, at the specific price, and get it in writing before a booking fee changes hands.

70% built, and the questions that follow

The government file records 70.12% complete — the developer’s own return under the statutory 7(f) report. Past two-thirds, delivery risk is receding and the handover questions matter more: vacant possession date, defect liability period, strata title timeline, and the first year’s maintenance charge and sinking fund per square foot. On a 320-unit tower of one-bedroom units, the maintenance charge is a larger share of your holding cost than most buyers assume — ask for the figure per square foot, not per month.

Use the statutory name for documents

If you ask for “Hugoz Suites” at a land office or a bank, you may be told there is no such scheme. Ask for MENARA SUTERA RIA, project code 30370-1.

Track record

About Armada Istimewa Sdn Bhd (EXSIM Group)

The developer named on the permit is Armada Istimewa Sdn Bhd, registration number 201401009297 (1085375-U), correspondence care of EXSIM Development Sdn Bhd at D-35-01, Level 35, EXSIM Tower, Millerz Square @ Old Klang Road, 58000 Kuala Lumpur. It holds developer’s licence 30370/02/2028/0047(A), valid 14 February 2023 to 13 February 2028.

EXSIM is one of the most prolific compact-format developers in Kuala Lumpur, and it has built a recognisable house style: small floor plates, heavy facilities decks placed high in the tower rather than on a low podium, and a marketing identity built around a single stylised name. Hugoz is one of a cluster the group is putting up in the same pocket — Kyliez, Hanaz and now Phoeniz Suites, the last of which is roughly fifty metres away on the same block.

One practice worth crediting without reservation: EXSIM publishes quarterly construction photographs for this project, unbroken from the first quarter of 2025 to the third quarter of 2026. Most Malaysian developers publish nothing at all between launch and handover. You can date the structure yourself and check the rate of climb against the September 2027 completion target on the permit.

The permit also discloses something buyers rarely read: the land is charged to CIMB Bank Berhad. That is entirely normal development finance, not a warning sign, but it has a practical consequence — your solicitor will need the bank’s redemption statement and disclaimer for your parcel at transfer. Build that step into your completion timeline rather than discovering it late.

What EXSIM has not published for Hugoz: the number of storeys, the land area, the maintenance charge, the sinking fund rate, and whether the Type C studio office units fall under this permit or a separate one. Those blanks are asked about in the FAQ below rather than filled in with guesses.

Hugoz Suites @ KL City Centre construction progress photograph, first quarter 2025
Site progress · Q1 2025
Hugoz Suites @ KL City Centre construction progress photograph, first quarter 2026
Site progress · Q1 2026

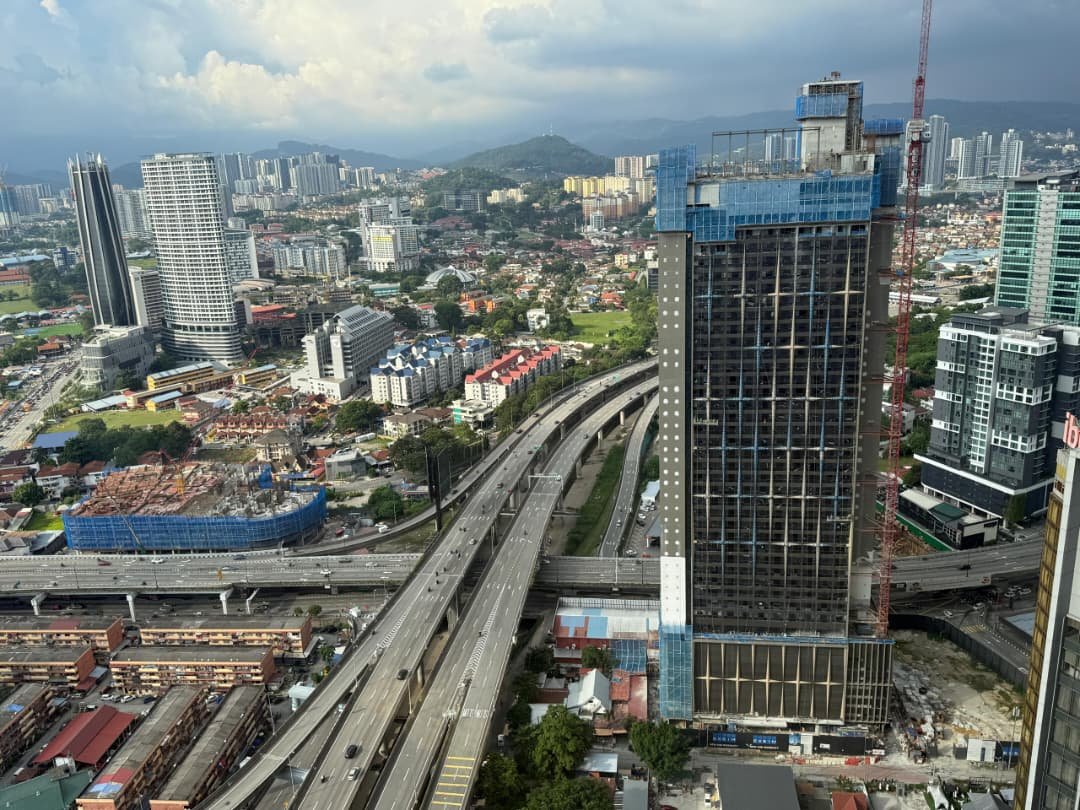

Hugoz Suites @ KL City Centre construction progress photograph, third quarter 2026
Site progress · Q3 2026
Hugoz Suites @ KL City Centre tower under construction, third quarter 2026 site photograph
Tower under construction · Q3 2026
Straight answers

Frequently asked questions

Can foreigners and Singaporeans buy at Hugoz Suites?

Only the units priced at RM1,000,000 or above — and the permit range starts at RM915,515. Kuala Lumpur prohibits foreign interests from acquiring any property valued under RM1 million per unit, and the definition of foreign interests includes Malaysian permanent residents. That means a slice of this price list is simply closed to you, and it is the cheaper slice.

Ask for the price list by layout and by floor, and identify which specific units clear RM1,000,000. Do not rely on “prices start from” marketing: the threshold is applied unit by unit, on the transaction value.

If the unit you want is a Type C studio office, there is a second gate. Under the Ministry of Economy’s acquisition guideline, a commercial property acquired by foreign interests must be registered in the name of a company incorporated in Malaysia. A foreign individual cannot hold it personally. Establish the title class of your unit in writing before you go any further.

Then the consent step: a transfer to a non-citizen needs written state consent under section 433B of the National Land Code. In the Federal Territory that is given by the Federal Territory of Kuala Lumpur Land Working Committee (Jawatankuasa Kerja Tanah Wilayah Persekutuan Kuala Lumpur), applied for through the Federal Territory Land and Mines Office after the sale and purchase agreement is signed. A dealing without consent is void.

Finally the tax. From 1 January 2026 a non-citizen buying residential property pays a flat 8% stamp duty on the transfer, with the statutory definition of residential expressly covering a service apartment. On a RM1.05 million unit that is RM84,000 at transfer.

Is Hugoz Suites 320 units or 674?

The statutory permit says 320. The particulars printed at the foot of hugoz.com.my read “Bilangan Unit: 320 Unit” and “Jenis Pembangunan: Pangsapuri Servis”. Property portals routinely publish 674 units and 46 levels.

Those two statements cannot both be describing the same approval. The most obvious explanation is that the studio office component is licensed separately from the serviced apartments — that is a common structure and EXSIM used something similar on other projects — but I have not seen a second permit, so I am not going to state it as fact.

What you do about it: ask the sales team, in writing, for every developer’s licence number and every advertising and sale permit number that covers this tower, and for the unit count under each. Then you will know exactly how many parcels share your lifts, your management fund and your resale market.

This matters more than it looks. If the true figure is 674 rather than 320, your share of common property, the queue for two or three lift cars at 8am, and the number of near-identical units competing with yours in 2028 all roughly double.

Is Type C an apartment or an office?

EXSIM’s own drawing labels it a studio office. The room schedule for Type C lists a pantry, an office and a washroom. There is no bedroom and no kitchen. Types A and B are drawn as residential suites with a bedroom, living, dining, kitchen and bathroom.

If your unit is on commercial title, four things change at once: assessment rates and utility tariffs are charged at commercial rather than domestic rates; banks typically lend a lower margin than on a home; the statutory protections of the Housing Development Act may not apply in the same way; and for a foreign buyer the property must be held through a Malaysian-incorporated company.

There is one point that runs the other way. The 8% non-citizen stamp duty introduced on 1 January 2026 applies to residential property, and the statute defines that as a house, condominium, apartment, flat, service apartment or SOHO used as a dwelling. An office lot is outside that definition and stays on the ordinary tiered rates. So for some foreign buyers the office product is cheaper to acquire in duty terms — while being harder to hold and to finance.

None of this can be resolved by asking a salesperson verbally. Ask for the layout code of the specific unit, then ask for the title particulars for that code in writing.

How much are the units and what does the price include?

RM915,515 to RM1,345,960, with a 2% Bumiputera discount. That is the range disclosed on the advertising and sale permit, and it is the only official price information EXSIM publishes.

What the permit does not tell you is the price of any specific unit. Price varies by layout, by floor, by facing and by stack, and developer price lists in Kuala Lumpur are revised repeatedly through a launch. The permit range is a boundary, not a quote.

It also does not tell you what is included. Ask specifically about: furnishing level and whether appliances are in the sale and purchase agreement or in a separate letter, the rebate or discount structure, whether legal fees on the agreement and the loan are absorbed, the car park allocation per layout, and the estimated maintenance charge per square foot.

I will get you the current price list and put the differences between layouts side by side, so you can see what you are actually paying per square foot rather than per unit.

Will it really be finished in September 2027?

September 2027 is the date on the permit, and unusually you can check it yourself. EXSIM has published site progress photographs every quarter from the first quarter of 2025 to the third quarter of 2026 without a gap. That is not normal practice in this market and it is genuinely useful.

Do this before you sign: open the last four quarters side by side and count the floors gained per quarter. Then extrapolate to the top of the tower and compare with the stated completion date. If the arithmetic does not reach September 2027, you have a specific question to put to the developer rather than a vague worry.

Remember what the date on a permit means legally. Under a standard Housing Development Act sale and purchase agreement, vacant possession is due within a set period from the date of the agreement, and late delivery attracts liquidated damages calculated on the purchase price. The permit date is the developer’s expectation; your agreement is what you can actually enforce. Read the delivery clause and the LAD clause before you accept any timeline.

The advertising and sale permit itself expires on 14 September 2026. Ask for the renewed permit particulars — a valid permit is a legal requirement for selling, not an administrative detail.

What does “land charged to CIMB Bank” on the permit mean for me?

It means the developer financed the land, which is ordinary — but it adds a step at completion. The permit particulars disclose the encumbrance as a charge (gadaian) in favour of CIMB Bank Berhad, and separately record that there is no restriction in interest on the title.

The practical effect is that your parcel has to be released from the developer’s charge before it can be transferred to you clean. Your solicitor will obtain a redemption statement and a disclaimer or partial discharge for your unit from the bank, and part of the purchase money is normally paid directly to the chargee bank rather than to the developer.

This is routine on almost every new development in Malaysia. It becomes a problem only when a developer runs into trouble, which is exactly why it is disclosed. What you should do is make sure your solicitor confirms the redemption arrangement in writing early, rather than at the last week before completion.

The related good news on this title: no restriction in interest. That removes one of the two common obstacles for a foreign transfer — the remaining one being the state consent under section 433B.

How many storeys is the tower, and what is the land area?

EXSIM does not publish either figure, so neither is stated on this page as fact. The highest level named anywhere in its official material is the Level 43A pool deck, which tells you the tower is at least that tall and no more.

Portals commonly quote 46 levels and a land area of about 0.867 acres. Those numbers do not appear in any EXSIM document I could find, so I am treating them as unverified.

Why it matters: the number of residential floors above the pool deck determines how many units share that deck, and the land area determines the plot ratio and how tightly the tower sits against its neighbours — including the EXSIM project going up fifty metres away.

Ask for the approved building plan reference and the certified schedule of parcels. The building plan number is already published on the permit as BP T3 OSC 2022 2398; the developer can retrieve the approved drawings against it.

Should I buy Hugoz, or wait for Phoeniz next door?

Today the honest answer is Hugoz, because Hugoz has published documents and Phoeniz has not. Hugoz gives you a developer’s licence number, an advertising permit number, a tenure, a unit count, a price range, a completion date and eight quarters of construction photographs. For Phoeniz, EXSIM has published renderings, three unit plans and a site progress page that reads “Coming Soon”.

That is not a judgement about which building will be better. It is a statement about what you can verify before you part with money. If Phoeniz publishes its permit particulars and they compare favourably, the answer can change.

There is a timing argument in the other direction. Phoeniz will complete later and will therefore be the newer product when both are trading. If you are buying for a ten-year hold, being the older tower fifty metres from the newer one is a real consideration, and it should be reflected in the price you pay for Hugoz rather than ignored.

My working test: buy the building whose documents you have read. Send me both and I will lay the two permits side by side the moment Phoeniz has one.

What will it rent for, and to whom?

The catchment is the honest strength here. Jalan Yap Kwan Seng sits inside the Jalan Ampang office and embassy corridor, with two rail lines inside a ten-minute walk. That produces a real tenant pool of corporate staff and diplomatic households, and it is a different pool from a tourist-driven address.

The honest counterweight is supply. NAPIC recorded 4,181 unsold completed serviced apartment units in Kuala Lumpur in the first quarter of 2026. A 452 sq ft one-bedroom in KLCC is the single most replicated product in the city, and by 2028 you will also be competing with EXSIM’s own next tower fifty metres away.

Two levers actually move the number: the layout and the furnishing. A 646 sq ft Type B with a dual-key modification can be let as two tenancies, which changes the arithmetic materially compared with a 452 sq ft single suite. Ask what the dual-key option costs and whether it is available on your stack.

I will not quote you a yield without your purchase price and your unit. Send me both and I will build the number from current listings in the immediate area, and show you the listings I used.

Ask me for the current price list and the renewed permit number

The advertising permit displayed on the project website runs to 14 September 2026. Before you pay anything, you want the renewed permit particulars, the current price list by layout, and written confirmation of whether the unit you like is the serviced apartment product or the studio office product. I will get all three and send them to you as they come.

No agent fee payable by the buyer on new developer launches

Louis Koh

11 years in Malaysian property · Johor Bahru & Kuala Lumpur new launches · English & 中文

I work with cross-border buyers from Singapore and with local investors. I'll tell you when a project isn't right for you — that's usually worth more than the brochure.

💬 Message Louis

Published 2026-08-11 · Last verified 2026-08-11 against Armada Istimewa Sdn Bhd (EXSIM Group)'s published project material. Unit availability, pricing and completion dates are set by the developer and subject to change. This page is marketing information, not an offer or a contract.

Hugoz Suites @ KL City CentreFreehold · 320 units · 323–646 sq ft · target Sept 2027
WhatsApp

Ask a specific question

If you would rather not use WhatsApp, use this. I answer them myself. Only your name and one contact method are required.

Email or phone — one is enough

What you send is emailed to me and stored on this site. It goes to no third party, joins no mailing list, and fires no tracking. See the privacy policy.

Build progress

How far up it actually is

Not the developer’s account of itself. These are the certified completion percentages and the status word the Ministry of Housing and Local Government records against the project, from the 7(f) returns. The vocabulary is theirs: Lancar (on schedule), Lewat (behind), Sakit (sick), Terbengkalai (abandoned).

30370-1 · MENARA SUTERA RIA (HUGOZ SUITES @ KL CITY CENTRE)

Overall status: Lancar — on schedule

ComponentUnitsCompleteStatusCCC
Pangsapuri Servis32070.12%Lancar

Read from teduh.kpkt.gov.my on 2026-09-05, project code 30370-1. Re-read weekly.

What to do with the number. Read it against the delivery date in your own agreement, not against what a salesperson says. A project with a year left on its statutory clock and a third of the building up is telling you something the brochure will not.
