Murraya @ Tamansari, Rawang
179 two-storey terraces behind the Tamansari gates — with no advertising permit, no price and no completion date published. This page tells you what is actually known, and what is not.
⚡ Typical reply within 15 minutes, 9am–10pm MYT · No obligation

Murraya @ Tamansari, Rawang at a glance
Half of this table says not published. That is the honest state of Murraya in August 2026 and it is the reason this page exists — a phase at registration stage generates a great deal of confident-sounding content on listing sites, none of which the developer has stood behind.
- Development
- Murraya @ Tamansari, RawangNewest named phase of the township
- Licensed developer
- Pinggir Mentari Sdn Bhd (939134-H)Named on sibling phases; not on Murraya’s page
- Product
- Two-storey terraced housesGated, guarded and curated, per BRDB
- Residences
- 179Described by BRDB as an enclave
- Layouts
- 3 — A, A1/A2, BDrawings published; sizes not
- Tenure
- Freehold township landStated for Tamansari as a whole
- Price
- Not publishedNo permit price band exists yet
- Advertising and sales permit
- Not publishedNo permit block on the Murraya page
- Completion date
- Not publishedIgnore any date you see on a listing site
- Built-up and lot size
- Not publishedDrawings exist but carry no published dimensions on the page
- Status
- Open for registrationBRDB’s own wording on its registration form
- Foreign buyers
- Cannot be assessed without a priceZone 1 floor is RM2,000,000 — see the FAQ
Explore related topics
Curated hubs, each with its own guide — not auto-generated tag archives.
Five reasons Murraya is worth registering for — and three it is too early to buy
An unlaunched phase is a different kind of decision from an unsold one. What you are really evaluating at this stage is the township, the developer and your own patience, because the house itself has no published price, size or date.
179 homes, not 1,790
BRDB describes Murraya as an enclave of just 179 exclusive residences. In a township planned for over 1,800 homes across more than 15 phases, launching in blocks of this size is how a developer avoids flooding its own resale market. Your future competition when you sell is 178 neighbours, not a thousand.
The green is township-wide, not phase-specific
BRDB attributes 65 acres of natural greenery, parks and undulating hills to the 245-acre township, and says 30% of space goes to gardens and parks. Those numbers belong to Tamansari as a whole, so they apply to Murraya the same way they apply to Jasmin — no more, no less.
It has its own gateway, and that is unusual here
Murraya is the only Tamansari phase whose page carries dedicated renderings of a phase entrance, a playground swing, a jogging path and a shelter. The completed phases publish site plans and floor plans and nothing else. Whether those get built is a separate question, but the intent is at least on the record.
You can inspect the finished product next door
Four Tamansari phases are already built: Amaryllis and Camelia as three-storey terraces, Dahlia and Jasmin as two-storey. Murraya is a two-storey terrace, so Dahlia and Jasmin are your build-quality reference — go and look at the plasterwork, the drains and the road width before you register anywhere.
Five expressways, published on this phase’s own page
The Murraya page is where BRDB actually publishes its connectivity table: KLCC 35 km, Mid Valley 32 km, Bangsar 30 km, Subang 28 km, Bandar Utama 25 km, with the North-South Expressway, NKVE, LATAR, the Guthrie Corridor Expressway and the Rawang Bypass named as the routes.
Too early: there is no permit, no price and no date
No advertising and sales permit block appears on the Murraya page. No price band. No expected completion date. No built-up area. No lot dimensions. Any of those you find quoted elsewhere came from somewhere other than the developer, and you should treat them accordingly.
Too early: you cannot even run the foreign-buyer test
Selangor’s Zone 1 floor for non-citizens is a price test at RM2,000,000. With no price published, the test cannot be run. On the evidence of the adjacent Jasmin phase, whose permit ceiling is RM1,474,300, it is unlikely Murraya reaches it — but unlikely is not the same as known.
Too early: nobody can tell you when you move in
Jasmin’s permit carried an expected completion of October 2025 and BRDB now lists it as completed — that is what a dated commitment looks like. Murraya has no such date on any BRDB page. If your timeline is fixed by a tenancy ending or a child starting school, this phase cannot yet be planned around.
The whole development, decoded
Three layout codes, three drawings, zero dimensions. BRDB has published the plans for A, A1/A2 and B on the Murraya page without stating a built-up area, a lot width or a lot depth for any of them.
The three published layouts
Type A
The base code in the Murraya set, with its own drawing published on BRDB’s Murraya page. The developer has not stated a built-up area, a lot width or a lot depth for it, and it has not stated how many of the 179 units are Type A. Listing sites quote a 20 by 70 foot lot and a figure in the 1,800s — neither appears on any BRDB page.
Type A1 / A2
BRDB publishes A1 and A2 on a single shared drawing, which normally means a mirrored or handed pair rather than two different houses. That is worth confirming with the sales team, because a mirrored pair affects which side your driveway and your service yard end up on, and that is not a cosmetic detail on a terrace lot.
Type B
The third published code, and on the strength of the drawing the widest of the three. Note that the letter B here is not the same product as Type B in the neighbouring Jasmin phase — the two phases run entirely separate code sets, which is one of the clearest signs that Murraya is a distinct product and not a relaunch of Jasmin under a new name.
What Murraya shows that the older phases do not
Murraya is the only Tamansari phase with its own set of phase-level amenity renderings — a gateway, a swing, a jogging path, a shelter. That is a genuine content difference from the completed phases, whose pages carry only site plans and floor plans. Renderings are intent, not delivery.
Rendered for Murraya specifically
- Phase entrance and gateway statement
- Playground with swing
- Jogging path
- Shelter or gazebo
- Front facade and end-lot facade treatments shown separately
Township-wide
- 65 acres of natural greenery, parks and undulating hills
- 30% of space committed to gardens and parks
- Integrated perimeter security system
- Road network shared with the four completed phases
Stated but undated
- Clubhouse — BRDB stated in 2015 it would be free to residents; no current page confirms it is built
- Lakeside open space — referenced in township copy, not located on a published plan
- Whether the Murraya renderings are contractual — the site disclaimer says they are not
Not published at all
- Price band
- Advertising and sales permit number
- Expected completion date
- Built-up area and lot dimensions per type
- Unit mix — how many of the 179 are A, A1/A2 or B
- Monthly maintenance and security charge
Where the project is now

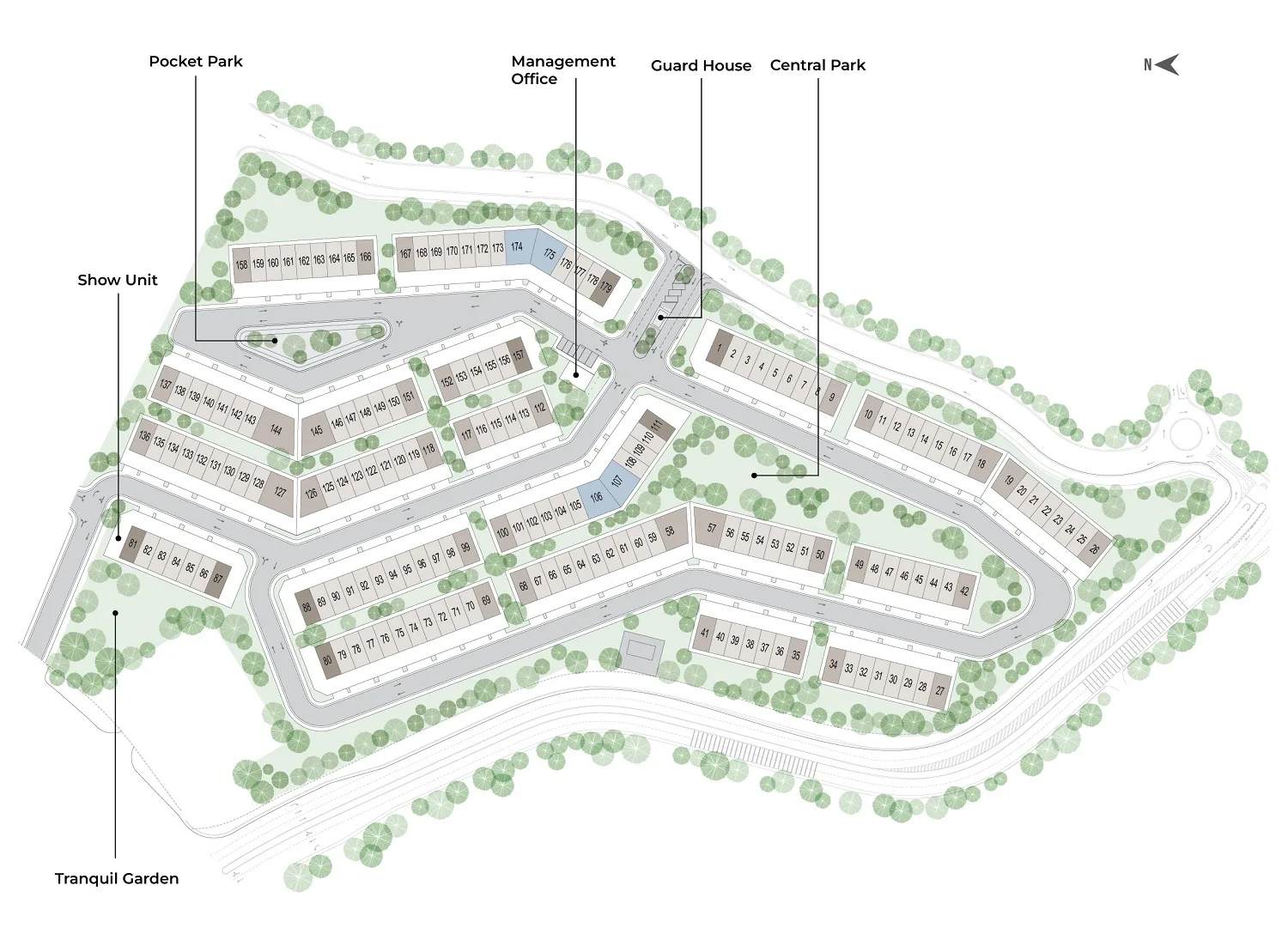

All 3 Murraya @ Tamansari, Rawang floor plans
The three Murraya drawings are on BRDB’s own site and they are the only Murraya-specific technical documents in public. They are not reproduced here because they are not yet licensed onto our media library. Message me for the original files.
Inside Murraya @ Tamansari, Rawang

Where Murraya @ Tamansari, Rawang sits
Tamansari, Sungai Bakau, 48000 Rawang, Selangor — the same 245-acre township as the completed Jasmin, Dahlia, Camelia and Amaryllis phases, in the Gombak district under Majlis Perbandaran Selayang.

The pin is the Tamansari sales gallery, decoded from BRDB’s own Waze deep link on the township site. Murraya’s own parcel boundary has not been published, so nobody should be quoting you a lot-level coordinate yet.

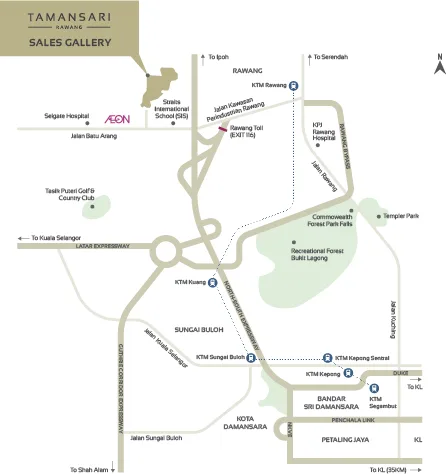

- Kuala Lumpur city centre (KLCC)35 kmPublished on the Murraya page itself
- Mid Valley32 kmPublished on the Murraya page itself
- Bangsar30 kmPublished on the Murraya page itself
- Subang28 kmPublished on the Murraya page itself
- Bandar Utama25 kmPrinted as 25cm on BRDB’s page — a typo
- North-South ExpresswayRoute listedNo distance published
- NKVERoute listedNo distance published
- LATAR ExpresswayRoute listedNo distance published
- Guthrie Corridor ExpresswayRoute listedNo distance published
- Rawang BypassRoute listedCredited by BRDB with shortening the KL commute
Registered as “Murraya”, licensed to Pinggir Mentari Sdn Bhd — and not started
| Project code | Registered name | Licensed developer | Advertising permit | Permit expires | Units | Bed / bath | Price band on the permit | Built | Status |
|---|---|---|---|---|---|---|---|---|---|
| 13819-6 | Murraya | Pinggir Mentari Sdn Bhd (13819) | 13819-6/03-2029/0215(A)-(S) | 16 Mar 2029 | 179 | 4 / 3–4 | RM1,092,000 – RM1,613,000 | 0.00% | Belum Mula |
Swipe sideways to see the full table →
Read from teduh.kpkt.gov.my on 27 August 2026. Pull it yourself: teduh.kpkt.gov.my/semakan-status-kemajuan?kodProjek=13819-6
One caution before you use this table
The district field on this record is blank in the register. The scheme name matches exactly and the product type is consistent with this development, but I am telling you what I could not confirm rather than leaving it out. Ask the sales team to confirm the project code is 13819-6 before you rely on the figures above — it takes one question and it removes the ambiguity entirely.
Belum Mula means construction has not started
The register’s vocabulary is fixed: Belum Mula (not started), Lancar (on schedule), Lewat (late), Sakit (distressed), Siap Dengan CCC / CFO (completed), Permit Telah Dibatalkan (permit cancelled).
Not started is normal for a newly permitted scheme and it is also the point of maximum delivery risk. Everything on offer exists on paper. Read the delivery clause and the liquidated damages provision in the sale and purchase agreement before you read the brochure, and write down today’s reading — 0.00%, checked 27 August 2026 — so that you have a baseline to compare against.
Foreign buyers
Selangor’s minimum for a non-citizen buyer is RM2,000,000 for most property types. The permitted band tops out at RM1,613,000, so nothing here reaches the threshold.
About Pinggir Mentari Sdn Bhd (BRDB Developments)

The licensed developer across the Tamansari phases is Pinggir Mentari Sdn Bhd (939134-H), part of BRDB Developments Sdn Bhd (5521-A). That is the entity named on the permit blocks of the completed Tamansari phases. On Murraya’s own page there is no permit block at all — no developer licence number, no advertising permit, no building plan reference, no approving authority line.
That absence is the most useful fact on this page, so it is worth being precise about what it does and does not mean. It does not mean the developer is unlicensed — the group’s licence 13819/02-2027/0078(R) runs to 5 February 2027 and is printed on sibling phases. What it means is that Murraya has not been given its own advertising and sales permit, or has not been given one that BRDB has chosen to publish. Under the Housing Development (Control and Licensing) Act 1966, a licensed developer needs a valid advertising and sales permit before it advertises or offers units for sale, and BRDB’s own language reflects that: its registration form describes Murraya as open for registration, not open for sale.
So the developer is behaving consistently. It is collecting interest, not deposits. The risk is not the developer’s conduct; the risk is that a buyer treats a registration page as a launch and starts making decisions on numbers that do not legally exist yet.
On the group itself: BRDB built Bangsar Shopping Centre and the Bangsar estate the company was named after. It was taken private and delisted from Bursa Malaysia on 29 October 2012, after Ambang Sehati Sdn Bhd crossed 97% through a general offer. A private developer publishes no quarterly accounts, so you cannot check the balance sheet before you commit the way you could with a listed counterparty. Weigh that more heavily on an unbuilt phase than on a finished one.
One thing in the group’s favour on a phase like this: BRDB has publicly said it deliberately slows launches rather than pushing volume. Chief executive Christopher Manivannan told The Edge in April 2022 that the group used the pandemic years to clear unsold stock and that the idea is not to produce more stock. A developer that launches 179 units at a time into a 15-phase township, ten years into a decade-long build-out, is behaving the way it says it does.
Frequently asked questions
Is Murraya actually on sale, or only open for registration?
Open for registration. That is BRDB’s own wording on its own form, and the documentary evidence supports it.
The Tamansari registration form lists the preferred-project options as Jasmin, Murraya and Sari. Next to Murraya it says open for registration, while the others are described as ongoing. Separately, the Murraya page carries no advertising and sales permit block at all — no permit number, no validity period, no building plan approval reference, no approving authority. Its sibling phases all carry one.
Under the Housing Development (Control and Licensing) Act 1966 a licensed developer needs a valid advertising and sales permit before it advertises or offers units for sale. The absence of that block on Murraya’s page is consistent with a phase that has not reached that stage yet.
The practical consequence: you can express interest and get on a list. You should not be paying a booking fee, signing a booking form, or being quoted a firm price for a specific lot. If anyone offers you any of those three today, ask to see the permit number first.
Why is there no price, and why won’t you estimate one?
Because an estimate on this page would be indistinguishable from a fact once someone screenshots it.
There is no price band because there is no advertising and sales permit, and the price band is a component of the permit. It is a statutory disclosure, not a marketing choice. When the permit issues, a minimum and a maximum will be printed on it, together with any Bumiputera discount, and that becomes the number this page carries.
What you can reason from, carefully: the adjacent Jasmin phase — same township, same developer, also two-storey terraces — carries a permit band of RM987,850 to RM1,474,300. Murraya is a later phase, so it will very probably not be cheaper. That is a direction of travel, not a number, and I am not going to convert it into one.
If you see a specific Murraya price quoted on a listing site, ask that site where it came from. It did not come from BRDB.
Can a foreign buyer or Singaporean register for Murraya?
You can register. Whether you can complete is a question nobody can answer yet, and the odds are against it.
Selangor runs a district-zone system for non-citizen purchases. Rawang is in the Gombak district — confirmed by the approving authority on the sibling phases’ permits, Majlis Perbandaran Selayang. Gombak is Zone 1, and Zone 1 sets a RM2,000,000 minimum purchase price for residential property bought by a foreign interest. Zone 3, at RM1,000,000, covers Hulu Selangor and Sabak Bernam and does not apply here.
The test is on the price of the unit you actually buy. Murraya has no published price, so the test cannot be run today. The nearest comparable — Jasmin, next door, same product type — tops out at RM1,474,300, which fails the test by RM525,700. Draw your own conclusion about the likelihood.
There is a second gate that price does not open. Selangor only permits foreign purchase of strata and strata-landed property; landed residential on an individual title is closed to non-citizens regardless of price, and there is a 10% ceiling on non-Bumiputera units in a development. BRDB stated in 2015 that Tamansari homes would be strata-titled, but the current permits say only freehold without specifying — so even the title question is unresolved.
Note also that foreign interest includes Malaysian permanent residents for these purposes. If you do complete a purchase in Malaysia as a non-citizen, budget for the flat 8% stamp duty on transfer that has applied to non-citizens since 1 January 2026 for residential property, and for real property gains tax at 30% within five years and 10% from the sixth year onward, with no zero band on exit.
State rules change without much notice. Have your own Malaysian lawyer confirm the current Selangor circular before you rely on any of this.
What exactly has BRDB published about Murraya, and what has it not?
Published: the name, the unit count of 179, the product type (two-storey terrace), three layout codes (A, A1/A2, B) with a drawing for each, a site plan, a set of artist’s impressions covering the front facade, the end-lot facade, the entrance, a swing, a jogging path and a shelter, a connectivity table of five KL-side distances, a list of five expressways, and the township-level claims of 245 acres and 65 acres of green.
Not published: the price, the advertising and sales permit number, the building plan approval reference, the approving authority, the developer licence number on this page, the expected completion date, the built-up area, the lot dimensions, the unit mix across the three codes, the phase acreage, the maintenance charge, and the title type.
That is a genuinely unusual balance — a full visual package with none of the statutory numbers. It is what a phase looks like when the marketing is ready and the paperwork is not.
The site’s own disclaimer, on every page, states that all information including specifications, facilities, plans, measurements and illustrations is subject to amendment without notification and is not intended to form and cannot form part of an offer or contract. That applies to the renderings above as much as to anything else.
How is Murraya different from Jasmin, really?
Different unit counts, different layout codes, different lifecycle stage, different marketing package. They are two products, not one product twice.
Unit count: 179 versus 173. Codes: A, A1/A2 and B versus B, BC2, C and CE1 — no overlap at all, and Jasmin explicitly splits corner from intermediate while Murraya does not label its codes that way. Stage: Murraya has no permit; Jasmin has a permit with a price band of RM987,850 to RM1,474,300 and an expected completion of October 2025, and BRDB now lists Jasmin as completed. Package: Murraya has phase-level amenity renderings — a gateway, a swing, a jogging path, a shelter — which Jasmin’s page does not carry.
If they were the same phase relaunched under a new flower name, you would expect at minimum the layout codes to survive. They did not.
The choice between them is really a choice between certainty and sequence. Jasmin gives you a house you can walk through and a number you can act on, minus whatever the good stock already sold. Murraya gives you first pick of a fresh 179, minus the ability to plan anything.
What does registering an interest actually commit me to?
Nothing, if it is done properly. That is exactly why it is worth doing early and why you should refuse anything more.
A registration of interest is a data capture: your name, contact, preferred layout and rough budget, so the developer can sequence its invitation list when the permit issues. It creates no contract, no priority you can enforce, and no obligation to buy. BRDB’s own form asks only for name, email, phone, a preferred call time, a preferred project and an optional message.
What would commit you is a booking form and a booking fee. At this stage, before an advertising and sales permit exists for the phase, you should not be signing or paying either. If that changes and a permit issues, the sequence becomes: permit published, price list released, booking form, then a statutory sale and purchase agreement within a set period.
One genuine benefit of registering early on a small phase: 179 units means the invitation list gets worked through quickly, and the position of the lot inside a terrace row matters enormously — end lots, lots facing green, lots away from the substation. Being on the list early is how you get a shot at those. It is not how you get a discount.
The developer entity, the brand and the parent — who am I actually dealing with?
Three names, one relationship, and it is worth getting straight before you sign anything.
Pinggir Mentari Sdn Bhd (939134-H) is the licensed housing developer named on the Tamansari permits. That is your counterparty on a sale and purchase agreement. BRDB Developments Sdn Bhd (5521-A) is the parent and the brand on the signage. The registered address for both is Level 11, Menara BRDB, 285 Jalan Maarof, Bukit Bandaraya, Kuala Lumpur.
Murraya’s page does not print the developer name at all — only the sibling phases do. When the Murraya permit issues, check that Pinggir Mentari is still the named developer and that the licence number matches. Developers sometimes use a different single-purpose vehicle per phase, and you want to know which balance sheet is behind your deposit.
The parent is private. BRDB was delisted from Bursa Malaysia on 29 October 2012 after a general offer by Ambang Sehati Sdn Bhd took its holding past 97%. That means no quarterly results and no public audited accounts to read before you commit. On a completed house that matters less; on an unbuilt phase where your money sits in a housing development account for three years, it matters more.
None of this is a red flag. It is a smaller information set than a listed developer gives you, and the correct response is to ask for more in writing rather than to assume the worst or the best.
Should I worry about the Selangor overhang before buying into an unbuilt phase?
Worry about the right number. Most of the published overhang is not this product.
NAPIC’s first quarter 2026 Selangor figures show a residential overhang of 3,745 units, of which the largest identifiable block is 2,407 completed and unsold serviced apartments. New launches in the quarter were 1,904 units, and the secondary market averaged RM559,935 per transaction.
Serviced apartments are strata high-rise, mostly in mature urban corridors, and they are a different market from 179 landed terraces on freehold township land in Gombak. The overhang number is not a reason to avoid Murraya.
What is worth thinking about: 1,904 new launches in a single quarter against an existing 3,745-unit overhang means Selangor is still adding supply faster than it is clearing it. In a market like that, the things that protect resale value are scarcity of the exact product, a title you can finance easily, and a neighbourhood that finishes. Murraya scores on the first, is unresolved on the second, and the third depends on BRDB rolling out the remaining phases of a 15-phase township over the next decade.
Quote the current quarter, not this one, by the time you read this. NAPIC data ages fast.
What should I ask at the sales gallery, in order?
Seven questions. Write them down and ask them in this order, because each one changes what the next one means.
One: has the advertising and sales permit been issued for Murraya, and what is the number? Cross-check it yourself on teduh.kpkt.gov.my. If the answer is no, everything else is provisional.
Two: is the title strata or individual? BRDB said strata for the township in 2015; the current permits say only freehold. This decides your management structure for life and, for non-citizens, whether purchase is possible at all.
Three: what is the built-up and the lot size for each of A, A1/A2 and B? Get it on the dimensioned drawing, not verbally.
Four: how many of the 179 units are each code, and where are the end lots? Ask to see the numbered site plan.
Five: what is the expected completion date that will go on the permit? Not the sales team’s guess — the date they intend to commit to in writing.
Six: what is the monthly maintenance and security charge, and who collects it? Nothing is published.
Seven: is there a clubhouse, is it built, and is it free? BRDB promised a free residents’ clubhouse at the 2015 township launch. Ten years on, no BRDB page confirms one exists.
Send me your answers and I will tell you which ones are normal and which ones are worth pushing back on.
Register through me and I will tell you the moment the permit is out
The only thing worth doing at this stage is getting on the list and then waiting for three documents: the advertising and sales permit, the price list, and the schedule of parcels. Tell me your budget and which layout you want, and I will bring you those three the day they exist rather than a brochure today.
No agent fee payable by the buyer on new developer launches. Registering an interest is not a booking and creates no obligation on either side.
Louis Koh
11 years in Malaysian property · Johor Bahru & Kuala Lumpur new launches · English & 中文
I work with cross-border buyers from Singapore and with local investors. I'll tell you when a project isn't right for you — that's usually worth more than the brochure.
Published 2026-08-12 · Last verified 2026-08-12 against Pinggir Mentari Sdn Bhd (BRDB Developments)'s published project material. Unit availability, pricing and completion dates are set by the developer and subject to change. This page is marketing information, not an offer or a contract.
Ask a specific question
If you would rather not use WhatsApp, use this. I answer them myself. Only your name and one contact method are required.
