Sanubari Phase 3 @ Bandar Dato’ Onn
Two hundred and two freehold terraces on one plan — 2,089 sq ft on 20 × 70 lots, four bedrooms plus a utility room, released as 3A and 3B with completion registered for December 2026 and March 2027.
⚡ Typical reply within 15 minutes, 9am–10pm MYT · No obligation



Sanubari Phase 3 @ Bandar Dato’ Onn at a glance
Every figure below comes from the developer’s own published material. Where the developer hasn’t published something, it isn’t on this page.
- Development
- Sanubari Phase 3 @ Bandar Dato’ OnnBy JLand Group (JLG Land Berhad)
- Tenure
- FreeholdIndividual title · no encumbrance registered on the land
- Homes in Phase 3
- 202Sanubari 3A 108 · Sanubari 3B 94
- Lot size
- 20 ft × 70 ft1,400 sq ft of land per home
- Built-up
- 2,089 sq ft194.1 sqm · the same for 3A and 3B
- Layout
- 4+1 bedrooms · 4 bathrooms3A: 2–3 car parks · 3B: 2 car parks
- Registered price band
- RM1,288,000 – RM1,935,000From the advertising permits · 15% Bumiputera discount
- Registered completion
- Dec 2026 and Mar 20273A December 2026 · 3B March 2027
- Approving authority
- Majlis Bandaraya Johor BahruBuilding plan MBJB/U/2024/14/BGN/131/RP(7)
- Foreign buyers
- RestrictedTitle needs State Authority consent · Johor landed floor is RM2,000,000
Explore related topics
Curated hubs, each with its own guide — not auto-generated tag archives.
Six things that make Phase 3 the phase to compare against
Phase 3 is the biggest single release at Sanubari and the most standardised — 202 homes running one built-up on one lot size. That has consequences, good and bad, and they are worth naming.
202 homes on one plan
Sanubari 3A is 108 homes and 3B is 94, and both carry the same 2,089 sq ft built-up on the same 20 × 70 lot. In ten years’ time that means the deepest pool of comparable resale evidence at Sanubari — the thing that makes a valuation argument easy rather than a negotiation.
2,089 sq ft on a 1,400 sq ft lot
Four bedrooms, a utility bedroom and four bathrooms across 194.1 sqm of built-up. It sits between Phase 1 (2,052 and 2,112 sq ft) and Phase 2’s deeper lots, on the same 20 ft frontage as Phase 1.
The 3A and 3B difference is car parks and timing
Same built-up, same lot, same building plan number. JLand lists Sanubari 3A with two to three car parks and 3B with two. The registered completion dates differ too — December 2026 for 3A, March 2027 for 3B. Those two details are the decision.
You can inspect Phase 1 before committing here
Phase 1 is built on the same masterplan by the same developer, and its first parcel carried a registered completion of July 2025. Walk it. Look at the finishes, the road levels, the drainage and how the guardhouse is actually staffed, then decide about Phase 3.
Smart home and solar, fitted as standard
Smart entrance lock, smart switches, CCTV, door and window sensors, a control hub, motorised curtains, air-conditioner control, a video doorbell, an EV charger point ready for wiring and six rooftop solar panels. Not an upgrade package — JLand lists it as the standard specification.
Freehold, with the approving authority on record
Freehold tenure, no encumbrance, approved by Majlis Bandaraya Johor Bahru under building plan MBJB/U/2024/14/BGN/131/RP(7), under developer’s licence 8918/10-2028/1240(A). You can check all of it on the government TEDUH portal rather than taking my word for it — and you should.
The whole development, decoded
Every number here is the developer’s own.
Pick your house type

Sanubari 3A
108 homes, registered at RM1,288,000 to RM1,878,000 on advertising permit 8918-65/12-2026/1177(N)-(L), issued 24 December 2024 with a registered expected completion of December 2026. JLand lists 3A with two to three car parks. When the permit was printed all 108 were still shown as available. JLand has not released exterior renders for Phase 3 — the image here is the shared Central Park. When the developer publishes Phase 3 imagery I will add it to this page.

Sanubari 3B
94 homes, registered at RM1,301,000 to RM1,935,000 on advertising permit 8918-68/05-2027/0391(N)-(L), issued 16 May 2025 with a registered expected completion of March 2027. Same 2,089 sq ft built-up and same building plan as 3A; JLand lists 3B with two car parks rather than two to three. JLand has not released exterior renders for Phase 3 — the image here is the shared Central Park. When the developer publishes Phase 3 imagery I will add it to this page.
What the neighbourhood gives you
Taken directly from the developer’s published facilities plan.
Central Park
- The Boulevard
- Central roundabout
- Plaza Sanubari
- Children’s play area
- Community orchard
- Elderly garden
- Urban farm
- Open lawn
- Picnic table area
- Linear park terrace
- Mini plaza
Sport and recreation
- 4.7 km jogging track
- 7.7 km bicycle track
- Multi-purpose court
- Half-court basketball
- Parcourse outdoor gym
- CrossFit and wall climbing
- 895 trees planted
Smart neighbourhood
- Public Wi-Fi across the neighbourhood
- Smart poles with CCTV and panic buttons
- Solar street lighting
- Rainwater harvesting
- Smart waste management
- Six rooftop solar panels per home
Security
- 24/7 security patrol
- Perimeter fencing CCTV
- CCTV in public areas
- Resident management system
- Visitor management system
- Panic button via the KITA app
Where the project is now
All 1 Sanubari Phase 3 @ Bandar Dato’ Onn floor plans
JLand publishes one floor plan drawing for Phase 3, covering the 3A layout. Sizes and configurations below are the developer’s official figures; message me for the full-resolution drawing and the 3B version.

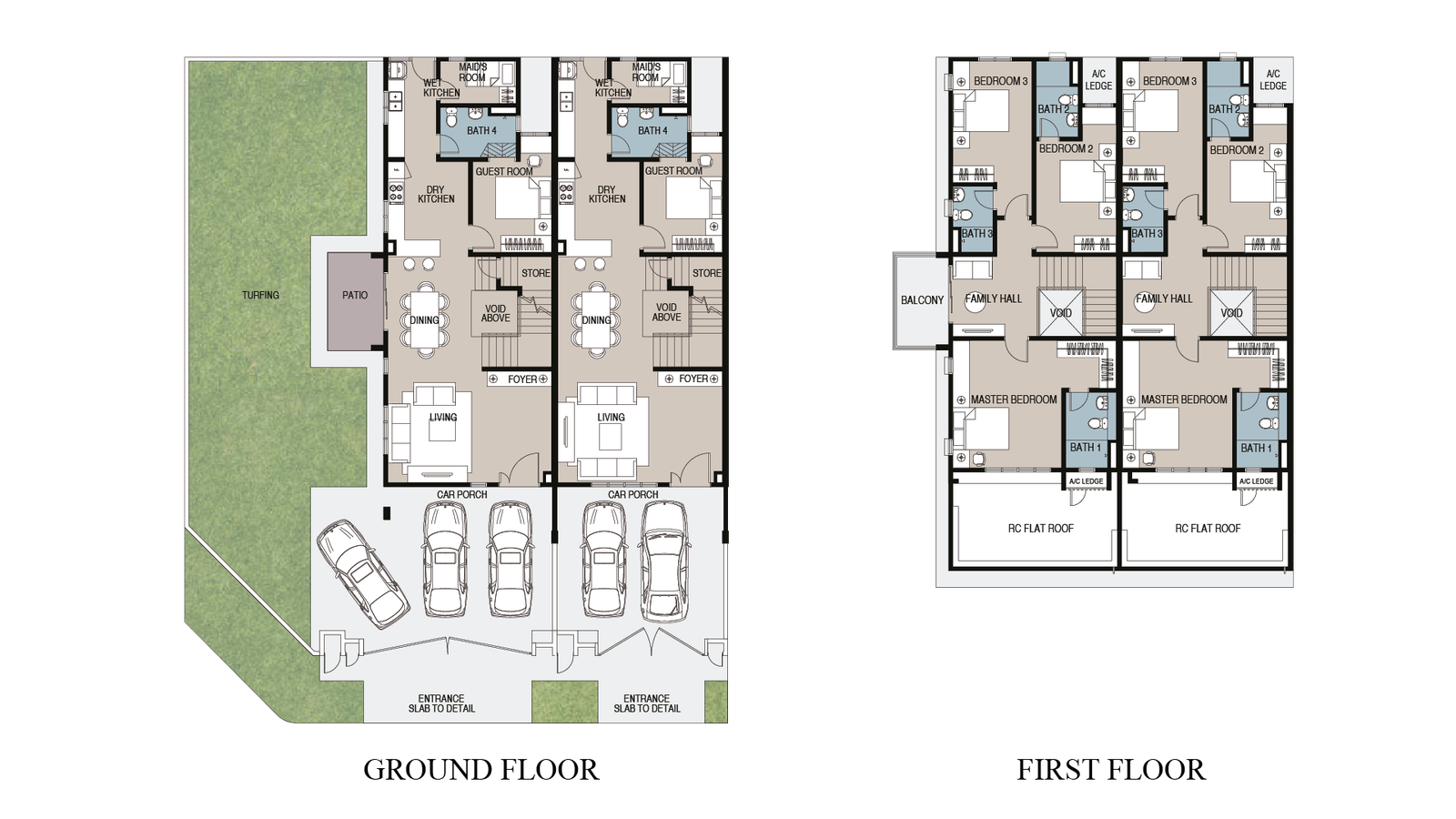

Type 3A — 2089 sq ft
Get this floor planInside Sanubari Phase 3 @ Bandar Dato’ Onn




Where Sanubari Phase 3 @ Bandar Dato’ Onn sits
Perjiranan 13 — Neighbourhood 13 — inside the Bandar Dato’ Onn township, 81100 Johor Bahru. An inland address reached by its own dedicated Bandar Dato’ Onn interchange off the North–South Highway, about 15 km by road from the Johor–Singapore CIQ.
Pinned to the development itself as registered in public mapping data, not to a nearby landmark.
- AEON Mall Bandar Dato’ Onn1.5 km3 min drive
- Kompleks Mutiara Johor Land1.5 km3 min drive
- Fairview International School2.2 km5 min drive
- Bandar Dato’ Onn Secondary School2.2 km5 min drive
- Malaysian College of Hospitality2.3 km6 min drive
- NIOSH Southern Regional Office2.4 km7 min drive
- Vista Viewpoint2.5 km6 min drive
- KPJ Bandar Dato’ Onn Specialist Hospital2.8 km7 min drive
- Tebing @ Bandar Dato’ Onn4 km8 min drive
- Mid Valley Southkey8.3 km10 min drive
- Toppen Shopping Centre and IKEA Tebrau10.2 km14 min drive
- Hospital Sultan Ismail10.3 km14 min drive
- Johor–Singapore CIQ complex15.2 km20 min drive
- Hospital Sultanah Aminah17.4 km22 min drive
The statutory name is not Sanubari — it is Perjiranan 13
Three project codes are registered with the National Housing Department under the name PERJIRANAN 13 (SANUBARI), all licensed to JLG Land Berhad (8918). Between them they cover 307 homes.
| Project code | Advertising permit | Permit expires | Units | Built-up | Bed / bath | Price band on the permit | Built | Status |
|---|---|---|---|---|---|---|---|---|
| 8918-65 | 8918-65/12-2026/1177(A)-(L) | 23 Dec 2026 | 108 | 194–208 sq m (2,088–2,239 sq ft) | 4–5 / 4 | RM1,288,000 – RM1,878,000 | 62.73% | Lancar |
| 8918-68 | 8918-68/05-2027/0391(N)-(L) | 15 May 2027 | 94 | 194–208 sq m (2,088–2,239 sq ft) | 4 / 4 | RM1,301,000 – RM1,935,000 | 5.00% | Lancar |
| 8918-69 | 8918-69/08-2027/0693(N)-(L) | 20 Aug 2027 | 105 | 199–210 sq m (2,142–2,260 sq ft) | 4 / 3 | RM1,300,800 – RM1,945,200 | 5.00% | Lancar |
| Total | 307 | Licensed developer: JLG Land Berhad (8918) | ||||||
Swipe sideways to see the full table →
Read from teduh.kpkt.gov.my on 27 August 2026. Pull any of them yourself: teduh.kpkt.gov.my/semakan-status-kemajuan?kodProjek=8918-69
I am not going to tell you which of these is “Phase 3”
The register does not use phase numbers. Nothing in the government record says which of 8918-65, 8918-68 or 8918-69 is the phase marketed as Sanubari Phase 1, Phase 2 or Phase 3. All three carry the same registered name.
I could guess from the permit dates, and the guess would probably be right. But if I attach the wrong figures to the wrong phase, a reader works out a price per square foot for a house they are not buying. The cost of being wrong here is higher than the cost of asking one more question.
So the figures above are labelled to the project code and to nothing else, and the question to put to the sales team is: “What is the KPKT project code for the phase you are selling me?”
Why the code matters more here than on most developments
One of these phases is 62.73% built. The other two are at 5.00%. That is not a detail — it is roughly two years of construction between them, and it decides when you get keys, how long you carry progress-payment interest, and how much delivery risk you are actually taking.
And the permit for 8918-65 expires on 23 December 2026. Selling must stop when a permit lapses unless it is renewed. If you are shown that phase after that date, ask for the renewal document first.
What the price bands settle
The three permitted bands run from RM1,288,000 to RM1,945,200. These are legal boundaries, not asking prices — the developer may not sell outside the band without varying the permit.
For a non-citizen buyer this is the decisive line: Johor’s minimum purchase price for landed property is RM2,000,000, and the top of the highest permitted band here is RM1,945,200. On the permit figures, no home in any of these three phases reaches the threshold — and state consent would be required on top of it in any case.
About JLand Group (JLG Land Berhad)

Phase 3 is registered to JLG Land Berhad (197201000788 / 12379-K), which operates as JLand Group. It has been the property development arm of Johor Corporation — the Johor state investment institution — since 1972, and Phase 3’s building plan is approved by Majlis Bandaraya Johor Bahru under reference MBJB/U/2024/14/BGN/131/RP(7).
What makes this developer unusual is that it built the township around the site rather than buying into one. JLand’s own figures for Bandar Dato’ Onn are 1,474 acres, of which 952 are already developed and 522 remain. Phase 3 buyers are therefore in the useful position of being able to audit the developer before completion — Phase 1 is standing, and streets JLand delivered a decade or two ago are a ten-minute drive away.
Sanubari is Neighbourhood 13: a 67.2-acre, 762-home enclave in four phases, reported at RM653 million GDV when it launched in late 2023, all under developer’s licence 8918/10-2028/1240(A) valid to 16 October 2028. Phase 3 alone is split across two permits — 8918-65/12-2026/1177(N)-(L) for 3A and 8918-68/05-2027/0391(N)-(L) for 3B. Both Johor Land Berhad and JLG Land Berhad appear on the statutory notices across the phases; it is one company that changed its name.
Frequently asked questions
How many homes are in Sanubari Phase 3, and what is the difference between 3A and 3B?
202 homes: 108 in Sanubari 3A and 94 in Sanubari 3B. Both are two-storey terraces on 20 ft by 70 ft lots with a 2,089 sq ft built-up, four bedrooms plus a utility bedroom and four bathrooms. They even share the same approved building plan number, MBJB/U/2024/14/BGN/131/RP(7).
Three things actually separate them. Car parks: JLand lists 3A with two to three and 3B with two. Timing: 3A is registered for December 2026 completion, 3B for March 2027. Price: 3A is registered at RM1,288,000 to RM1,878,000 and 3B at RM1,301,000 to RM1,935,000.
Everything else is the position of the lot within the phase — which corner you get, what you face, how far you are from the park and from the through road. That is the part worth spending an hour on, and it is the part no website can answer. Ask me for the current lot plan.
Can foreigners or Singaporeans buy at Sanubari Phase 3?
Effectively no. I would rather put that at the top than bury it, because the block is structural — it is not a matter of finding the right unit.
Start with the price floor. A non-citizen buying landed residential property in Johor must pay at least RM2,000,000. Phase 3’s registered band runs from RM1,288,000 to RM1,935,000, so the very top of the range is still RM65,000 short of the floor and no lot in the phase reaches it.
Then there is the land itself. The statutory notices for both 3A and 3B carry a restriction in interest printed in Malay: land held under this title may not be sold or transferred to a non-citizen or a foreign company without the consent of the State Authority. That sits on the title and travels with it.
Phase 3 is a Malaysian-buyer product, priced as one, with a 15% Bumiputera discount on the registered figures. If you are buying from Singapore or overseas, the RM1,000,000 Johor threshold you have read about applies to strata property — apartments and serviced residences, not terraces. Message me and I will build the shortlist that genuinely clears it, including what the 3% state levy and the 8% non-citizen stamp duty add to the total.
How much does a home at Sanubari Phase 3 cost, and what is the maintenance fee?
Unusually for a new launch, there is an official answer to the first half. Malaysian law requires the developer to register a price band with the National Housing Department and print it on the advertisement, so these are JLand’s own registered figures: Sanubari 3A at RM1,288,000 to RM1,878,000, and Sanubari 3B at RM1,301,000 to RM1,935,000. A 15% Bumiputera discount applies on top.
Two caveats I am not going to paper over. A registered band is a permitted range, not today’s price list — where a specific lot falls inside it depends on position, orientation and what is left. Both Phase 3 permits are still inside their validity period — 3A runs to 23 December 2026 and 3B to 15 May 2027 — so the registered bands are current. The availability count printed on the 3A permit showed all 108 homes still unsold when it was issued in December 2024, which is now well over a year old.
On the maintenance fee: JLand has not published the monthly charge for the gated-and-guarded community anywhere on the Sanubari project site, and I am not going to invent one. It is a real recurring cost on a guarded landed scheme and you should have the number before you commit.
I get the live price list, the current lot plan and the service charge direct from the sales gallery. Message me and I will send what is accurate today rather than what was accurate when the permit was printed.
When will Sanubari Phase 3 be handed over?
The registered expected completion dates are December 2026 for Sanubari 3A and March 2027 for Sanubari 3B, printed on advertising permits 8918-65/12-2026/1177(N)-(L) and 8918-68/05-2027/0391(N)-(L).
Those are declared targets on a statutory notice, not guarantees. The number that binds is in your sale and purchase agreement under the Housing Development Act — it sets the delivery period from the date of the agreement and the liquidated damages if the developer misses it. Have your conveyancing lawyer point at that clause and read it out to you.
Practical consequence: if you buy in 3B you are handing over money now for keys in 2027, on a phase where the developer has not yet released exterior renders. That is not a reason to avoid it — Phase 1 on the same masterplan is standing and inspectable — but it is a reason to see Phase 1 first.
Why are there no Phase 3 renders or show unit photos on this page?
Because JLand has not published any. The Sanubari project site carries one floor plan drawing for Phase 3A and nothing else — no facade render, no interior, no corner view, where Phases 1, 2 and 4 each have several.
I could have filled the gap with images from another phase or another project. I would rather leave the gap visible and tell you it is there. Everything on this page comes from JLand’s own project site, brochures and statutory notices; when Phase 3 imagery is published I will add it here and update the verification date at the foot of the page.
In the meantime the useful substitute is not a render — it is Phase 1, built by the same developer to the same masterplan, standing on the same neighbourhood. Message me and I will arrange for you to walk it.
How far is Sanubari Phase 3 from the Johor–Singapore checkpoint and the RTS Link?
The developer’s published figure is 15.2 km to the CIQ, about a 20-minute drive, and since the RTS Link’s Bukit Chagar station sits inside the CIQ complex, the same number applies to the train.
There is a timing point specific to Phase 3. Handover is registered for December 2026 (3A) and March 2027 (3B). RTS Link passenger service is currently targeted for early 2027, having slipped from 2026. So the first Phase 3 owners may take keys around the time the line opens — but the honest reading is that you would drive to Bukit Chagar and park, not walk to it.
Set the expectation accordingly. A 2,089 sq ft four-plus-one on a 1,400 sq ft lot is a family house in a mature township that happens to be within commuting range of the crossing. If proximity to the checkpoint is the whole thesis, say so and I will show you what is genuinely within walking distance of it instead.
What facilities do residents at Sanubari Phase 3 get?
Phase 3 does not get its own facility deck — it shares Central Park with Phases 1, 2 and 4. That is worth knowing before you buy, because it means the park is already planted and in use rather than something you wait for. JLand’s published schedule: 4.7 km of jogging track, 7.7 km of cycling track, a multi-purpose court, half-court basketball, an outdoor parcourse gym, a CrossFit and wall-climbing station, a children’s play area, an elderly garden, a community orchard, an urban farm and an open lawn, across 25 acres of green space with 895 trees planted.
The estate services come as standard: neighbourhood-wide public Wi-Fi, smart poles with CCTV and panic buttons, solar street lighting, rainwater harvesting, smart waste management, and six rooftop solar panels per home. It is gated and guarded with 24/7 patrolling, perimeter CCTV, and both resident and visitor management systems.
A caveat I would rather you hear from me. A clubhouse of 1.3 acres — pool, gymnasium, co-working space, multipurpose hall and two badminton courts — was described in a November 2023 press feature. It does not appear as a facility schedule on JLand’s current Sanubari site, so this page treats it as reported and unconfirmed. With Phase 3 handing over in December 2026 and March 2027, the timing question matters: ask me and I will get the clubhouse status in writing before you count on it.
The health package is published by the developer: complete health screenings for three years, terms and conditions apply, tied to KPJ Bandar Dato’ Onn Specialist Hospital 2.8 km away, with a panic button in the KITA app.
Who is the developer, and is there anything I should be careful about?
The developer is JLG Land Berhad (197201000788 / 12379-K), operating as JLand Group — Johor Corporation’s property development arm since 1972, and the party that built this township from scratch: 1,474 acres, 952 developed. Phase 3’s building plan is approved by Majlis Bandaraya Johor Bahru under MBJB/U/2024/14/BGN/131/RP(7). On completion risk, this is about as solid as Johor gets.
Three things still deserve your attention. The first is that Phase 3 has two registered completion dates, not one: December 2026 for 3A and March 2027 for 3B. Both are registered expected completions taken from the advertising permits — declared targets, not guarantees. Check which release your lot belongs to, then check the contractual delivery period and the liquidated damages clause in your sale and purchase agreement.
The second is the recurring cost of the shared estate. Central Park, the smart poles, estate Wi-Fi, the guardhouse and the solar street lighting are exactly what the premium buys, and the monthly charge for them is not published anywhere by JLand. Get the number, get the name of whoever runs the management body after handover, and get confirmation of what happens to the KITA app and the KPJ health scheme afterwards.
The third is that 202 homes is the largest single release at Sanubari, and Phase 4 has already been permitted behind it. Read the master layout before you choose a lot — which boundary faces the next construction front is not something that gets volunteered at the sales gallery. Ask me and I will send the current phasing plan.
Is a 202-home single-layout phase a good thing or a bad thing for resale?
Both, and which one it is depends on what you are optimising for. A deep pool of identical homes means that when you sell there will be recent transacted evidence on exactly your layout — valuers like that, banks like that, and buyers argue less. Pricing becomes a data question rather than a negotiation.
The cost of that is competition. If four of your neighbours list in the same quarter, you are all selling the same 2,089 sq ft product and the only differentiators left are lot position, condition and price. In a scarce type — Phase 2’s fifteen 22 ft units, say — that pressure does not exist.
My honest read: if you are buying to live in and hold, Phase 3’s standardisation is a mild positive and the lot position is what you should be fighting for. If you are buying with a five-to-eight-year exit in mind, take the scarcer type in a smaller phase, and take the corner.
I will not tell you which one to buy over a web page. Send me your holding period and I will show you the transacted evidence from the earlier phases so you can see how this has actually played out at Sanubari.
Get the current price list and unit availability
Developer pricing moves, and the good stacks go first. Tell me your budget and whether you’re buying to live in or to let — I’ll send back the units that actually fit, not a generic brochure.
No agent fee payable by the buyer on new developer launches
Louis Koh
11 years in Malaysian property · Johor Bahru & Kuala Lumpur new launches · English & 中文
I work with cross-border buyers from Singapore and with local investors. I’ll tell you when a project isn’t right for you — that’s usually worth more than the brochure.
Published 2026-08-03 · Last verified 2026-08-03 against JLand Group (JLG Land Berhad)’s published project material. Unit availability, pricing and completion dates are set by the developer and subject to change. This page is marketing information, not an offer or a contract.
