d'Courtyards @ Machang Bubok, Bukit Mertajam
Two finished phases, 145 freehold two-storey homes, and a private courtyard in the middle of every one. DSG’s link and super link houses stand 153 m from SK Machang Bubok II, with completion certificates dated August 2025 and April 2026. The whole permit band is below the mainland floor for landed homes, so foreigners cannot buy here.
⚡ Typical reply within 15 minutes, 9am–10pm MYT · No obligation

d'Courtyards @ Machang Bubok, Bukit Mertajam at a glance
Every figure below comes from the developer’s own published material or the government register. Where neither has published something, it isn’t on this page.
- Development
- d’CourtyardsRegistered as Taman Serikaya (Residensi BLT) · developer DSG Century Sdn Bhd
- Where it is
- Machang Bubok, Bukit MertajamOff Jalan Machang Bubok, Seberang Perai Tengah · 153 m from SK Machang Bubok II
- Tenure
- FreeholdStated on the developer’s website and as ‘Pegangan Kekal’ on its filed advertisement
- House types
- 2-storey super link and link homesLanded homes sold under Schedule G agreements
- Units
- 145 in two phasesPhase 1: 71 homes · Phase 2: 74 homes
- Layouts
- 4 bedrooms · 4 bathroomsLots 26′ x 65′, 22′ x 75′ and 21.6′ x 78′ · 173 to 203 sqm on the register
- Facilities
- Pocket garden and basketball courtJogging track, playground and benches · single-entry, guarded enclave according to the developer
- Completion
- Both phases completedCompletion certificates dated 10 Aug 2025 (Phase 1) and 17 Apr 2026 (Phase 2)
- Government permit
- 30113-1/03-2026/0119(R)-(L) · 30113-2/05-2026/0429(A)-(L)Ended 26 Mar 2026 and 15 May 2026 · no newer permits listed on 5 Oct 2026
- Foreign buyers
- Not open to foreignersEvery permit figure is below the RM1,000,000 mainland floor for landed homes
Explore related topics
Curated hubs, each with its own guide — not auto-generated tag archives.
What sets d’Courtyards apart — and what to settle first
Four strengths and two cautions, drawn from the developer’s website, the leaflet it filed for Phase 2 and the government housing register.
A courtyard inside the house
The whole scheme is named after its main idea. The developer says each home has its own courtyard, placed to bring daylight and natural ventilation into the middle of the plan, which is where an ordinary terrace house is darkest. Its website pitches the space for gardening, reading, pets or children’s play.
Built, certified and standing
There is no construction risk left to carry. The register records completion certificates and vacant possession for Phase 1 on 10 August 2025 and for Phase 2 on 17 April 2026. You can walk through the actual house, check the workmanship and see who your neighbours are before you commit.
Up to 26 ft of frontage
Type A super links stand on 26′ x 65′ lots; Type B link homes on 22′ x 75′; Type C on 21.6′ x 78′. Every type has four bedrooms and four bathrooms on the register, with recorded areas of 203, 176 and 173 sqm. The developer positions the wider Type A for several generations under one roof.
A pocket park behind one entrance
The developer describes a pocket garden with a paved path, jogging track, outdoor playground, basketball court and benches, inside an enclave with a single entry point and guards. It also states that the link homes are laid out on a north-south orientation to keep the interiors cooler.
For Malaysian buyers only
Across both phases the permit figures run from RM688,000 to RM986,920. A foreign individual needs a landed home on the mainland to reach RM1,000,000, so every house here sits below the floor. If you hold a foreign passport, ask me for landed projects that clear it.
Fourteen left, and three things to ask
Only 14 of the 145 homes were not yet recorded as sold on 5 October 2026, so choice of position is limited. Ask what the residents pay for guards and upkeep, because the developer has not published it. And note that the advertising permits on the register ended in March and May 2026 with no newer ones listed; I will confirm the position before any paperwork.
The whole development, decoded
Every number here is the developer’s own or the government register’s.
Pick your phase
Phase 1
The first 71 houses: 22 Type A super link homes and 49 Type B link homes. The register records the certificate of completion and compliance and vacant possession on 10 August 2025, so this phase already has residents and a street you can judge at night and at weekends. On 5 October 2026 the register showed all 22 super links recorded as sold and one Type B home still not recorded as sold.
Phase 2
Seventy-four more houses: 22 Type A super links, 43 Type B link homes and 9 Type C link homes, a type that exists only in this phase. The certificate of completion and compliance and vacant possession are both dated 17 April 2026 on the register. Thirteen homes were not yet recorded as sold when I read it — 2 Type A, 9 Type B and 2 Type C — so this is the phase to ask about if you want a brand-new house.
Facilities
As described on the developer’s website. Ask me how the guard service and garden upkeep are run and paid for today.
Pocket garden
- Landscaped pocket garden
- Paved path
- Jogging track
- Outdoor playground
- Basketball court
- Benches
Access and security
- Single entry point
- Guarded enclave, as described by the developer
- Marked walkways
- Street lighting
Inside every home
- Private courtyard
- High ceilings, according to the developer
- Car porch
- First-floor balcony on the published plans
Where the project is now

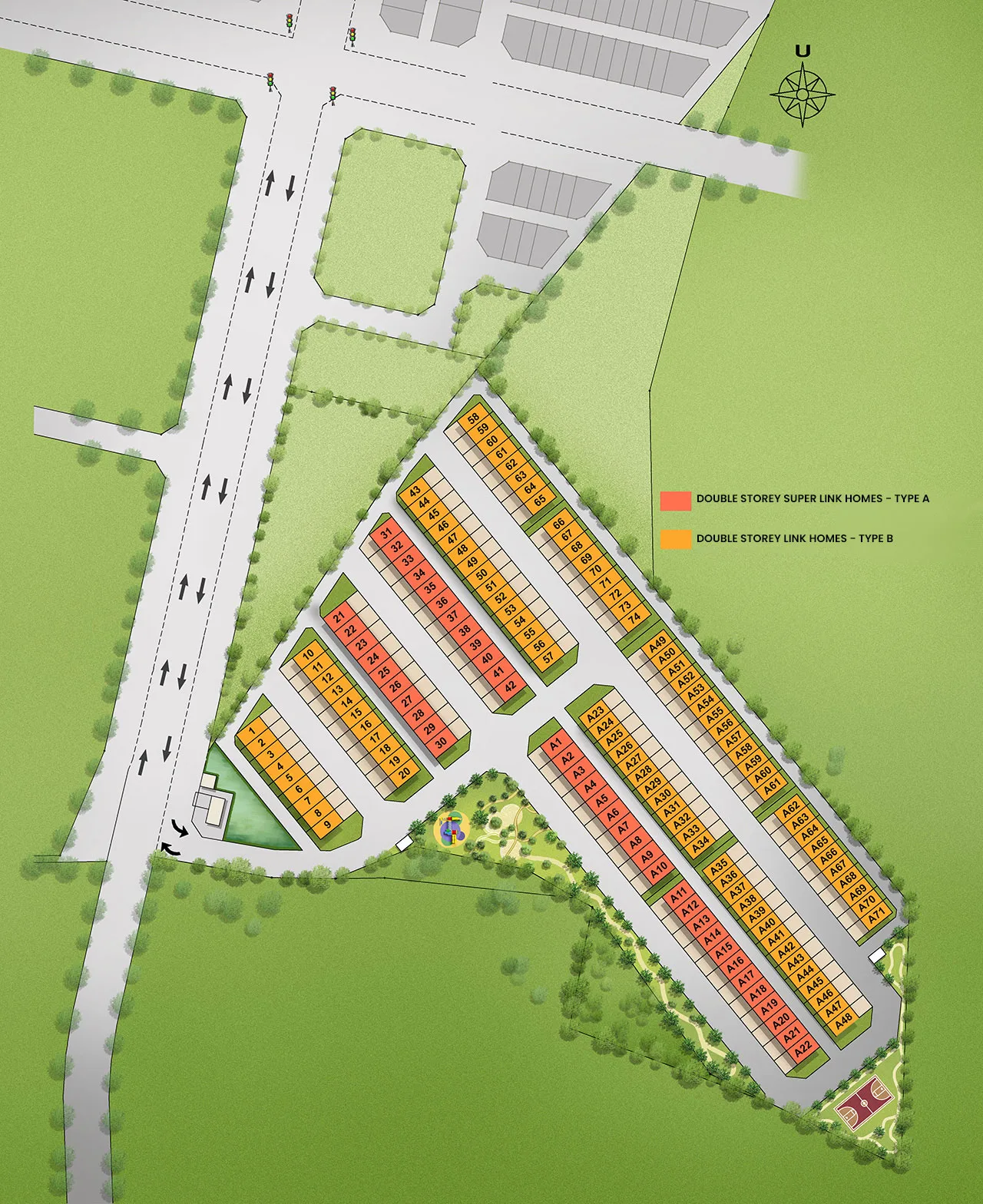

All 3 d'Courtyards @ Machang Bubok, Bukit Mertajam floor plans
Three plans, all two storeys with four bedrooms and four bathrooms. Lot and footprint dimensions are the developer’s; the areas in square metres are the ones recorded on the register for each type.

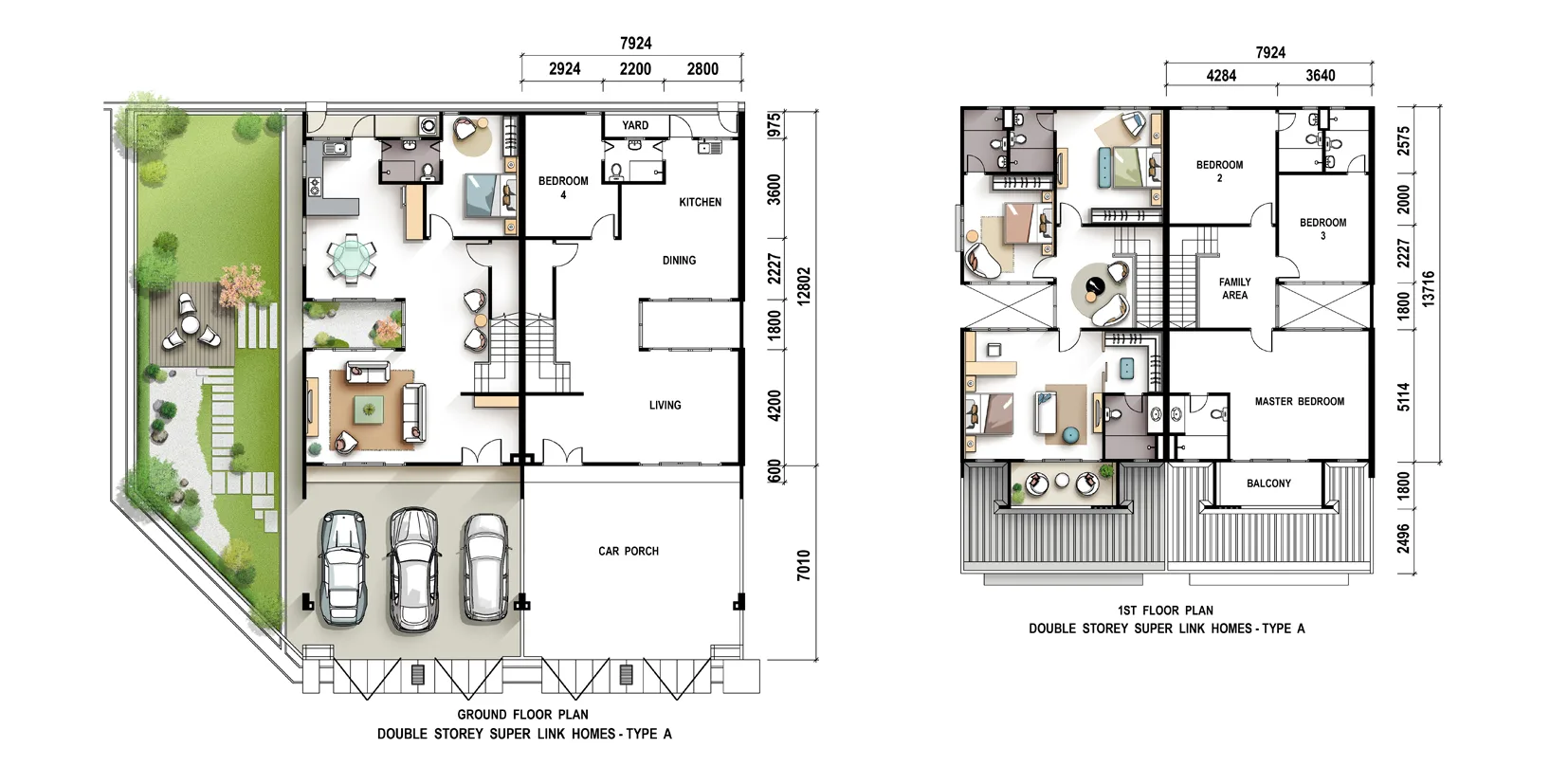

Type A · super link — 2,185 sq ft
Get this floor plan

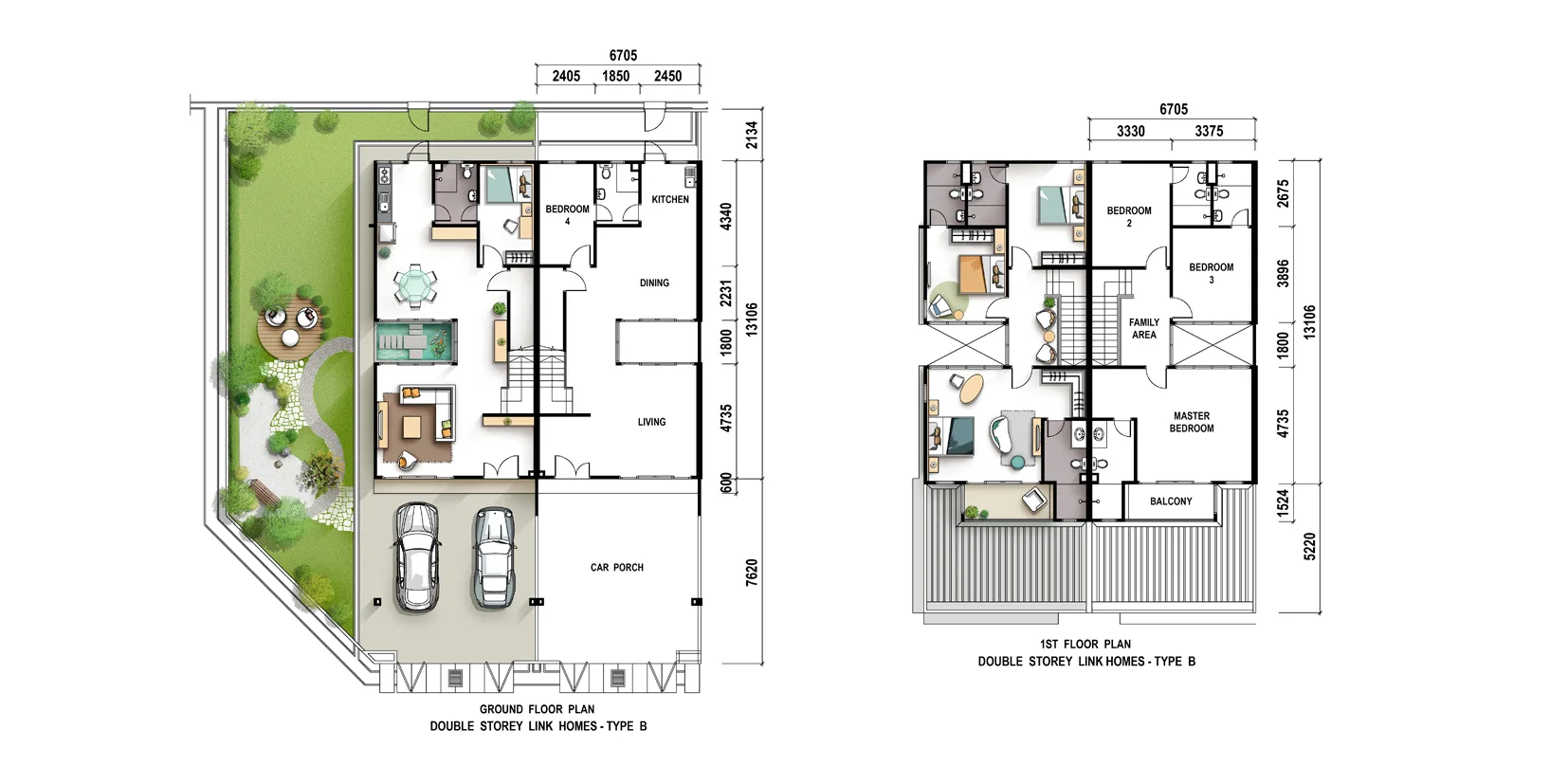

Type B · link home — 1,894 sq ft
Get this floor plan

Type C · link home (Phase 2 only) — 1,862 sq ft
Get this floor planInside d'Courtyards @ Machang Bubok, Bukit Mertajam

Where d'Courtyards @ Machang Bubok, Bukit Mertajam sits
In Machang Bubok on the eastern side of Bukit Mertajam, reached from Jalan Machang Bubok — 153 m in a straight line from SK Machang Bubok II and 2.9 km from AEON Mall Bukit Mertajam at Alma.
Pinned to the coordinates filed with the national housing register for Phase 1 (project 30113-1); Phase 2 is filed 65 m to the east. Distances are straight-line from the Phase 1 point.
- SK Machang Bubok II153 mstraight-line
- Vangohh Eminent Hotel524 mstraight-line
- SJK(C) Kay Sin908 mstraight-line
- AEON Mall Bukit Mertajam2.9 kmstraight-line
- Lotus’s Bukit Mertajam3.2 kmstraight-line
- Cherok Tokun Nature Park3.7 kmstraight-line
- Bukit Mertajam Hospital5.7 kmstraight-line
- Juru toll plaza, North-South Expressway7.4 kmstraight-line
- Penang Bridge17.6 kmstraight-line
On the government register it is Taman Serikaya — two phases, both completed
The housing developer’s licence is held by DSG Century Sdn Bhd (30113). d’Courtyards is the brand; the register files the scheme as Taman Serikaya, and the developer’s leaflet also carries the name Residensi BLT. Phase 1 is project 30113-1 and Phase 2 is 30113-2.
| Project code | Registered name | Advertising permit | Permit expires | Units | Bed / bath | Status |
|---|---|---|---|---|---|---|
| 30113-1 | Taman Serikaya, Phase 1 — Type A two-storey terrace, 203 sqm | 30113-1/03-2026/0119(R)-(L) | 26 Mar 2026 | 22 | 4 / 4 | Completed · CCC 10 Aug 2025 |
| 30113-1 | Taman Serikaya, Phase 1 — Type B two-storey terrace, 176 sqm | 30113-1/03-2026/0119(R)-(L) | 26 Mar 2026 | 49 | 4 / 4 | Completed · CCC 10 Aug 2025 |
| 30113-2 | Taman Serikaya, Phase 2 — Type A two-storey terrace, 203 sqm | 30113-2/05-2026/0429(A)-(L) | 15 May 2026 | 22 | 4 / 4 | Completed · CCC 17 Apr 2026 |
| 30113-2 | Taman Serikaya, Phase 2 — Type B two-storey terrace, 176 sqm | 30113-2/05-2026/0429(A)-(L) | 15 May 2026 | 43 | 4 / 4 | Completed · CCC 17 Apr 2026 |
| 30113-2 | Taman Serikaya, Phase 2 — Type C two-storey terrace, 173 sqm | 30113-2/05-2026/0429(A)-(L) | 15 May 2026 | 9 | 4 / 4 | Completed · CCC 17 Apr 2026 |
| Total | 145 | Licensed developer: DSG Century Sdn Bhd (30113) | ||||
Swipe sideways to see the full table →
Read from teduh.kpkt.gov.my on 5 October 2026. Check it yourself: teduh.kpkt.gov.my/semakan-status-kemajuan?kodProjek=30113-1 and kodProjek=30113-2
71 plus 74 makes 145
Phase 1 is filed as 22 two-storey terrace houses of 203 sqm and 49 of 176 sqm, which matches the 22 Type A and 49 Type B homes on the developer’s website. Phase 2 is filed as 22 houses of 203 sqm, 43 of 176 sqm and 9 of 173 sqm — Types A, B and C on the Phase 2 leaflet. On 5 October 2026 the unit lists showed 70 of 71 recorded as sold in Phase 1 and 61 of 74 in Phase 2, leaving 14 homes not yet recorded as sold.
Why the permit band rules out foreign buyers
The lowest figure on either permit is RM688,000 and the highest is RM986,920. That is the band on the advertising permit, not the price of any unit. Seberang Perai’s floor for a foreign individual buying a landed home is RM1,000,000, and the whole band is under it, so d’Courtyards is not open to foreigners. Malaysian citizens are not affected by the floor, wherever they live or work.
Schedule G and how the handovers went
Both phases were sold under Schedule G, which allows 24 months from the date of the agreement. Phase 1’s first agreement is dated 6 June 2023 and vacant possession is recorded on 10 August 2025, about two months after the 24-month date for that earliest agreement; no extension of time is recorded. Phase 2’s first agreement is dated 1 June 2024 and vacant possession is recorded on 17 April 2026, inside its 24 months.
Completed, with permit dates to confirm
Both phases are marked completed with a certificate of completion and compliance. The advertising permits shown on the register ended on 26 March 2026 for Phase 1 and 15 May 2026 for Phase 2, and no newer permits were listed when I read it on 5 October 2026. Before you place any money on one of the remaining homes, I will confirm with the developer the footing on which it is being sold.
About DSG Group
The developer is DSG Century Sdn Bhd, company number 202001031898 (1388218-K), part of the Bukit Mertajam-based DSG Group, whose logo is on the project website and leaflets. Its office is at No. 1 and 3, Jalan Maju Jaya, Pusat Perniagaan Maju Jaya, and the sales gallery is listed at Lot 1198, Jalan Machang Bubok.
The housing developer’s licence, 30113/07-2027/0112(A), runs from 8 July 2022 to 7 July 2027. Building plans were approved by Majlis Bandaraya Seberang Perai, and the Phase 2 leaflet filed with the register states freehold tenure and no encumbrance on the land.
On delivery, the record is mixed but complete. The website gave February 2025 as the expected date for Phase 1; the register shows it certified on 10 August 2025. The Phase 2 leaflet gave June 2026; the register shows it certified earlier, on 17 April 2026. Both phases are finished, which is the fact that matters most to a buyer today.
One caveat: the two phases of Taman Serikaya are the only entries under this licence on the national housing register, so there is no older residential scheme by the same licensee to inspect. The good news is that you do not need one. The houses themselves are standing; visit Phase 1, look at how they have weathered a year of use and talk to the people living there.
Frequently asked questions
How many homes are there at d’Courtyards?
145 in two phases. Phase 1 has 71 homes — 22 Type A super links and 49 Type B link homes. Phase 2 has 74 — 22 Type A, 43 Type B and 9 Type C.
By type that is 44 super links, 92 Type B link homes and 9 Type C link homes. The register showed 131 recorded as sold and 14 not yet sold on 5 October 2026.
Is d’Courtyards freehold?
Yes, according to the developer. Its website gives the tenure as freehold, and the Phase 2 leaflet filed with the housing register states ‘Pegangan Kekal’ and no encumbrance on the land.
These are landed homes under Schedule G, so each is meant to carry its own individual title. Have your solicitor confirm the title status of the specific lot at signing.
What are the lot sizes and layouts?
Type A super link: 26′ x 65′ lot with a 26′ x 42′ house footprint. Type B link home: 22′ x 75′ lot, 22′ x 43′ footprint. Type C link home, in Phase 2 only: 21.6′ x 78′ lot, 21.6′ x 43′ footprint. All have two storeys.
The register records four bedrooms and four bathrooms for every type, with areas of 203 sqm for Type A (about 2,185 sq ft), 176 sqm for Type B (about 1,894 sq ft) and 173 sqm for Type C (about 1,862 sq ft). Each plan includes the private courtyard.
Can foreigners buy at d’Courtyards?
No. Every figure on the two advertising permits is below RM1,000,000, which is the minimum for a foreign individual buying a landed home on mainland Penang.
If you are a foreign buyer who wants a landed house in Seberang Perai, tell me your budget and I will shortlist projects above the floor, and walk you through state consent, the 3% levy, the three-year resale restriction and the flat 8% stamp duty for non-citizens.
Is d’Courtyards completed? Can I move in straight away?
Yes, both phases are complete. The register records the completion certificate and vacant possession on 10 August 2025 for Phase 1 and 17 April 2026 for Phase 2.
For a home bought from the developer now, handover follows your agreement and the lender’s release of funds, with no building period to wait through. Ask me for the timeline on the specific house you choose.
Phase 1 or Phase 2 — which should I look at?
Nearly all the remaining choice is in Phase 2: 13 homes not yet recorded as sold there (2 Type A, 9 Type B, 2 Type C) against one Type B home in Phase 1. Phase 2 is also the only place to find Type C.
Phase 1 is the better place to judge the neighbourhood, because it has been occupied since August 2025. If a Phase 1 owner is selling, that is a resale purchase with its own paperwork; I can check what is available on the secondary market for you.
What is the price, and what are the monthly charges?
The only public price information is the government permit band. Across both phases the figures run from RM688,000 to RM986,920 — the band on the advertising permit, not the price of any unit. I do not repeat portal figures.
The developer describes the enclave as guarded but has not published what residents pay for guards or garden upkeep. Message me and I will get the current price list, the remaining lots and the charges in writing.
How does d’Courtyards compare with Taman Jasa Intan?
Both are completed freehold two-storey terrace schemes on this side of Bukit Mertajam, 1.1 km apart in a straight line. Taman Jasa Intan Garden Superlink at Alma is the larger one, 282 homes in four phases by Wing Tai Asia; d’Courtyards has 145 homes in two phases by DSG.
The difference is the plan. d’Courtyards is designed around an internal courtyard and a single guarded entrance with its own pocket park. Read the Taman Jasa Intan page for its house sizes, then visit both: completed houses are best compared on foot.
What is daily life like in Machang Bubok, and is there rental demand?
SK Machang Bubok II is 153 m away, SJK(C) Kay Sin 908 m, AEON Mall Bukit Mertajam 2.9 km, Lotus’s Bukit Mertajam 3.2 km and Bukit Mertajam Hospital 5.7 km, all straight-line. Cherok Tokun Nature Park, the town’s hill-walking spot, is 3.7 km north.
A four-bedroom landed house in a guarded enclave mostly suits families who intend to live in it. Tenants in this part of Bukit Mertajam tend to be families and people working in the mainland industrial parks. I do not quote rental figures; ask me for current evidence before you buy to let.
Ask which units are available now
Completed projects change hands unit by unit, and whatever the developer still holds moves too. Tell me your budget and whether you’re buying to live in or to let — I’ll send back the units that actually fit.
Completed project — what is for sale changes unit by unit, so ask before you plan a viewing
Louis Koh
11 years in Malaysian property · Johor Bahru, Kuala Lumpur & Penang new launches · English & 中文
I work with cross-border buyers from Singapore and further afield, and with local investors. I’ll tell you when a project isn’t right for you — that’s usually worth more than the brochure.
Published 2026-10-05 · Last verified 2026-10-07 against The developer’s project website (dcourtyards.com), its leaflet filed with the housing register, and the KPKT housing register. Unit availability, pricing and completion dates are set by the developer and subject to change. This page is marketing information, not an offer or a contract.
Ask a specific question
If you would rather not use WhatsApp, use this. I answer them myself. Only your name and one contact method are required.
Developer: DSG Group (1 development on this site)
Where it is: Bukit Mertajam, Penang
The unit mix, the permitted price and how far up it is
None of this table is the developer’s account of itself. It is what the Ministry of Housing and Local Government records from the 7(f) returns: unit type, bedrooms and bathrooms, built-up area, unit count, the price range on the permit, and the certified percentage complete. A brochure price can be revised; the price on the permit was filed. A brochure need not mention progress; the percentage is certified. The status vocabulary is theirs too: Lancar (on schedule), Lewat (behind), Sakit (sick), Terbengkalai (abandoned).
30113-1 · TAMAN SERIKAYA
Overall status: Siap Dengan CCC — completed
| Component | Bed / bath | Built-up | Units | Price on the permit | Complete |
|---|---|---|---|---|---|
| Rumah Teres 2 storeys Siap Dengan CCC | 4 / 4 | 203 m² ≈ 2,185 sq ft | 22 | RM738,000.00 – RM887,200.00 | 100.00% |
| Rumah Teres 2 storeys Siap Dengan CCC | 4 / 4 | 176 m² ≈ 1,894 sq ft | 49 | RM688,000.00 – RM860,500.00 | 100.00% |
Swipe the table sideways for the rest of the columns.
This is the document the developer had to file, and the housing department had to approve, before it was allowed to advertise at all — served from the ministry’s own host. It normally carries the location plan, the developer licence and building-plan approval references, the expected completion date, the encumbrance position, and the unit count and price floor and ceiling for each type. The brochure a salesperson hands you can be reissued. This one cannot.
Read from teduh.kpkt.gov.my on 2026-10-08, project code 30113-1. Re-read weekly.
30113-2 · TAMAN SERIKAYA
Overall status: Siap Dengan CCC — completed
| Component | Bed / bath | Built-up | Units | Price on the permit | Complete |
|---|---|---|---|---|---|
| Rumah Teres 2 storeys Siap Dengan CCC | 4 / 4 | 176 m² ≈ 1,894 sq ft | 43 | RM728,000.00 – RM915,520.00 | 100.00% |
| Rumah Teres 2 storeys Siap Dengan CCC | 4 / 4 | 173 m² ≈ 1,862 sq ft | 9 | RM728,000.00 – RM986,920.00 | 100.00% |
| Rumah Teres 2 storeys Siap Dengan CCC | 4 / 4 | 203 m² ≈ 2,185 sq ft | 22 | RM778,000.00 – RM976,200.00 | 100.00% |
Swipe the table sideways for the rest of the columns.
This is the document the developer had to file, and the housing department had to approve, before it was allowed to advertise at all — served from the ministry’s own host. It normally carries the location plan, the developer licence and building-plan approval references, the expected completion date, the encumbrance position, and the unit count and price floor and ceiling for each type. The brochure a salesperson hands you can be reissued. This one cannot.
Read from teduh.kpkt.gov.my on 2026-10-08, project code 30113-2. Re-read weekly.
What to do with the number. Read it against the delivery date in your own agreement, not against what a salesperson says. A project with a year left on its statutory clock and a third of the building up is telling you something the brochure will not.
How does that compare? Every development on this site, grouped by register status — cancelled, abandoned and behind schedule first.
